California Radio Interoperable System (CRIS) - 9D2 - Sites Logs - Statewide Logs
Posted: Sun Nov 28, 2021 6:33 am
by Brian
California Radio Interoperable System (CRIS)
System ID: 9D2
WACN: BEE00
System Type: Project 25 Phase II
https://www.radioreference.com/apps/db/?sid=10819
Node 4697: California Radio Interoperable System (CRIS)
Site: Tuscan Butte (Tehama County)
https://www.broadcastify.com/calls/node/4697
https://www.broadcastify.com/calls/tg/10819?time=1wk
https://www.broadcastify.com/calls/tg/10819?time=all
RR Wiki: California Radio Interoperable System (CRIS): Site Research
https://wiki.radioreference.com/index.p ... e_Research
Reminder: Please do not submit, or share the info with RadioReference
Some Possible Site Locations:
Boucher Hill (Palomar Mtn) - San Diego County
Red Mtn (Fallbrook) - San Diego County
Mt Woodson - San Diego County
Cuyamaca Peak - San Diego County
Soledad (La Jolla) - San Diego County
San Miguel - San Diego County
The primary Control Channels in the 769.xxxx or 770.xxxx range.
The alternate control channels in the 773.xxxx 774.xxxx range.
The frequencies are licensed under WPTZ774, the 700 MHz Public Safety State License (SL) to the State of California.
The state has a 17MHz block granted to them; 96 12.5khz channels for total of 192 Frequencies.
Radio Service: SL: Public Safety 700 MHZ Band - State License
https://www.radioreference.com/db/fcc/callsign/WPTZ774
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=2377057
2019 Attachment
https://wireless2.fcc.gov/UlsApp/Applic ... D=11555152
2014 Attachment
https://wireless2.fcc.gov/UlsApp/Applic ... ID=8364718
HISTORY:
2022 –
Phase 4 plans to install VHF highband repeaters sites in Mono County and
700 MHz repeaters in the San Diego, Imperial, San Bernardino, Riverside, and Kern Counties.
https://www.caloes.ca.gov/CRIS
https://www.caloes.ca.gov/office-of-the ... stem-cris/
California Radio Interoperable System (CRIS) 5-Year Roadmap - (Maps)
http://www.napco.org/documents/2020-07_CRIS.pdf
California Public Safety Radio
Communications Strategic Plan
September 3, 2010
https://www.caloes.ca.gov/PublicSafetyC ... c_Plan.pdf
RR Forum Thread (33+ pages): California Radio Interoperable System (CRIS)
https://forums.radioreference.com/threa ... is.397492/
Talkgroups:
139 - PSC Area 09 - Los Angeles / Ventura
141 - PSC Area 11 - Riverside / Southern Border
143 - PSC Area 33 - Fixed M/W Maintenance Operations North
202 -
220 -
800 - CHP Southern Black - Central Los Angeles (15)
802 - CHP Central Los Angeles (15) Area Office
805 - CHP Southern Brown - Altadena (98)
815 - CHP Southern Orange - Baldwin Park (81)
819 - CHP Southern Pink - West Los Angeles (79)
833 - CHP Southern White - South Los Angeles (77)
834 - CHP Southern White Tac-A
835 - CHP South Los Angeles (77) Area Office
838 - CHP Southern Yellow - East Los Angeles (82)
839 - CHP Southern Yellow Tac-A
842 - CHP Southern Blue
1059 -
1612 -
1626 -
1636 -
1642 -
1648 -
1657 -
1725 -
1938 - Franchise Tax Board Headquarters
2089 -
2090 -
8026 - CHP Southern Investigative Services Unit 2
50001 - Law 1 - Statewide
50002 - Law 2 - Statewide
50013 - Fire 3 - Statewide
50043 - EMS 3 - Statewide
____________________________________________
1-12 - 773.05625 - Strawberry Peak, San Bernardino***
1-24 - 769.90625 - Rincon Peak, Ventura
1-25 - 773.55625 - South Mountain, Ventura
1-27 - 769.40625 - Oat Mtn, Los Angeles
1-28 - 770.94375 - Hauser Peak, Los Angeles
1-29 - 773.34375 - Mt. Lukens, Los Angeles***
1-30 - 773.56875 - Santiago Peak, Riverside***
1-47 - 773.80625 - Cuyamaca Peak, San Diego
1-48 - 773.30625 - Red Mtn (Fallbrook), San Diego***
1-54 - 769.96875 - Mt. Woodson, San Diego
1-56 - 770.65625 - Chuckwalla Mountain, Riverside
1-58 - 774.33125 - Rodman Mountain, San Bernardino
1-59 - 773.06875 - Government Peak, Kern
1-67 - 770.40625 - Toro Peak, Riverside
_____________________________________________
____________________________________________
1-27 - 769.40625 - Oat Mtn, Los Angeles
1-24 - 769.90625 - Rincon Peak, Ventura
1-54 - 769.96875 - Mt. Woodson, San Diego
1-67 - 770.40625 - Toro Peak, Riverside
1-28 - 770.94375 - Hauser Peak, Los Angeles
1-56 - 770.65625 - Chuckwalla Mountain, Riverside
1-12 - 773.05625 - Strawberry Peak, San Bernardino***
1-59 - 773.06875 - Government Peak, Kern
1-48 - 773.30625 - Red Mtn (Fallbrook), San Diego***
1-29 - 773.34375 - Mt. Lukens, Los Angeles***
1-25 - 773.55625 - South Mountain, Ventura
1-30 - 773.56875 - Santiago Peak, Riverside***
1-47 - 773.80625 - Cuyamaca Peak, San Diego
1-58 - 774.33125 - Rodman Mountain, San Bernardino
_____________________________________________
Re: California Radio Interoperable System (CRIS) - San Diego County Area Sites in 2022
Posted: Sun Nov 28, 2021 6:34 am
by Brian

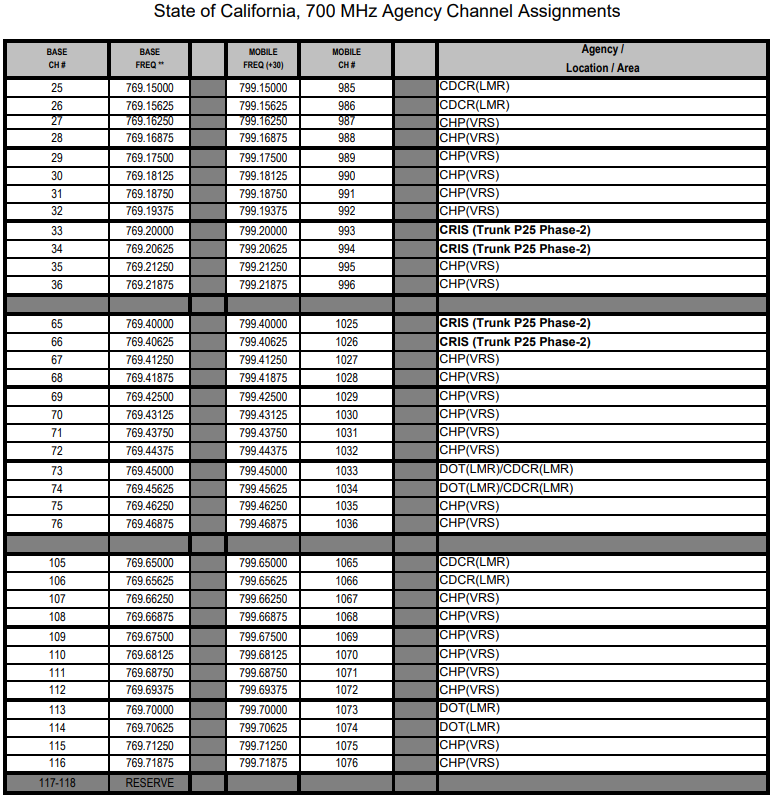

State of California, 700 MHz Agency Channel Assignment - Call Sign WPTZ774 Info:
BASE --- BASE ----- MOBILE ----- MOBILE - Agency/Location/Area -- [(SoCal Site Notes from RRDB)]
CH# ---- FREQ ** -- FREQ(+30) -- CH# -
Ch.25 - 769.15000 - 799.15000 - Ch.985 - CDCR(LMR) -----
Ch.26 - 769.15625 - 799.15625 - Ch.986 - CDCR(LMR) -----
Ch.27 - 769.16250 - 799.16250 - Ch.987 - CHP(VRS) ------
Ch.28 - 769.16875 - 799.16875 - Ch.988 - CHP(VRS) ------ [CHP Orange1 Extender Primary]
Ch.29 - 769.17500 - 799.17500 - Ch.989 - CHP(VRS) ------
Ch.30 - 769.18125 - 799.18125 - Ch.990 - CHP(VRS) ------ [CHP TAN1 Extender Primary]
Ch.31 - 769.18750 - 799.18750 - Ch.991 - CHP(VRS) ------
Ch.32 - 769.19375 - 799.19375 - Ch.992 - CHP(VRS) ------ [CHP Gold1 Extender Primary]
Ch.33 - 769.20000 - 799.20000 - Ch.993 -----------------
Ch.34 - 769.20625 - 799.20625 - Ch.994 -----------------
Ch.35 - 769.21250 - 799.21250 - Ch.995 - CHP(VRS) ------
Ch.36 - 769.21875 - 799.21875 - Ch.996 - CHP(VRS) ------ [CHP Orange1 Extender Alternate]
Ch.65 - 769.40000 - 799.40000 - Ch.1025 ----------------
Ch.66 -
769.40625 - 799.40625 - Ch.1026 ----------------
(CRIS Site 29 Mount Lukens)
Ch.67 - 769.41250 - 799.41250 - Ch.1027 - CHP(VRS) -----
Ch.68 - 769.41875 - 799.41875 - Ch.1028 - CHP(VRS) ----- [CHP Gold1 Extender Alternate]
Ch.69 - 769.42500 - 799.42500 - Ch.1029 - CHP(VRS) -----
Ch.70 - 769.43125 - 799.43125 - Ch.1030 - CHP(VRS) -----
Ch.71 - 769.43750 - 799.43750 - Ch.1031 - CHP(VRS) -----
Ch.72 - 769.44375 - 799.44375 - Ch.1032 - CHP(VRS) -----
Ch.73 - 769.45000 - 799.45000 - Ch.1033 - DOT(LMR)/CDCR(LMR) -----
Ch.74 - 769.45625 - 799.45625 - Ch.1034 - DOT(LMR)/CDCR(LMR) ----- [2A9 Site 1-5 Richard J. Donovan CDCR Prison]
Ch.75 - 769.46250 - 799.46250 - Ch.1035 - CHP(VRS) ------
Ch.76 - 769.46875 - 799.46875 - Ch.1036 - CHP(VRS) ------
Ch.105 - 769.65000 - 799.65000 - Ch.1065 - CDCR(LMR) ----
Ch.106 - 769.65625 - 799.65625 - Ch.1066 - CDCR(LMR) ---- [2A9 Site 1-5 Richard J. Donovan CDCR Prison]
Ch.107 - 769.66250 - 799.66250 - Ch.1067 - CHP(VRS) -----
Ch.108 - 769.66875 - 799.66875 - Ch.1068 - CHP(VRS) ----- [CHP Tan1 Extender Alternate]
Ch.109 - 769.67500 - 799.67500 - Ch.1069 - CHP(VRS) -----
Ch.110 - 769.68125 - 799.68125 - Ch.1070 - CHP(VRS) -----
Ch.111 - 769.68750 - 799.68750 - Ch.1071 - CHP(VRS) -----
Ch.112 - 769.69375 - 799.69375 - Ch.1072 - CHP(VRS) -----
Ch.113 - 769.70000 - 799.70000 - Ch.1073 - DOT(LMR) -----
Ch.114 - 769.70625 - 799.70625 - Ch.1074 - DOT(LMR) -----
Ch.115 - 769.71250 - 799.71250 - Ch.1075 - CHP(VRS) -----
Ch.116 - 769.18750 - 799.18750 - Ch.1076 - CHP(VRS) -----
Ch.117-118 - RESERVE
Ch.145 - 769.90000 - 799.90000 - Ch.1105 - CDCR(LMR) ----
Ch.146 -
769.90625 - 799.90625 - Ch.1106 - CDCR(LMR) ----
(CRIS Site 24 - Rincon Peak - Primary control channel)
Ch.147 - 769.91250 - 799.91250 - Ch.1107 - CHP(VRS) -----
Ch.148 - 769.91875 - 799.91875 - Ch.1108 - CHP(VRS) ----- [CHP Brown Extender Primary]
Ch.149 - 769.92500 - 799.92500 - Ch.1109 - CHP(VRS) -----
Ch.150 - 769.93125 - 799.93125 - Ch.1110 - CHP(VRS) -----
Ch.151 - 769.93750 - 799.93750 - Ch.1111 - CHP(VRS) -----
Ch.152 - 769.94375 - 799.94375 - Ch.1112 - CHP(VRS) -----
Ch.153 - 769.95000 - 799.95000 - Ch.1113 ----------------
Ch.154 - 769.95625 - 799.95625 - Ch.1114 ----------------
Ch.155 - 769.96250 - 799.96250 - Ch.1115 - CHP(VRS) -----
Ch.156 -
769.96875 - 799.96875 - Ch.1116 - CHP(VRS) -----
(CRIS Site 29 Mount Lukens - Primary control channel)
Ch.185 - 770.15000 - 800.15000 - Ch.1145 ----------------
Ch.186 - 770.15625 - 800.15625 - Ch.1146 ----------------
Ch.187 - 770.16250 - 800.16250 - Ch.1147 - CDCR(LMR) ----
Ch.188 -
770.16875 - 800.16875 - Ch.1148 - CDCR(LMR) ----
(CRIS Site 24 - Rincon Peak - Alternate control channel) / [2A9 Site 1-5 Donovan CDCR Prison]
Ch.189 - 770.17500 - 800.17500 - Ch.1149 - CSP(LMR) -----
Ch.190 - 770.18125 - 800.18125 - Ch.1150 - CSP(LMR) -----
Ch.191 - 770.18750 - 800.18750 - Ch.1151 - CHP(LMR) -----
Ch.192 - 770.19375 - 800.19375 - Ch.1152 - CHP(LMR) -----
Ch.193 - 770.20000 - 800.20000 - Ch.1153 ----------------
Ch.194 -
770.20625 - 800.20625 - Ch.1154 ----------------
(CRIS Site 28 - Frazier Mtn? - Primary control channel)
Ch.195 - 770.21250 - 800.21250 - Ch.1155 - ABC - Statewide - VRS
Ch.196 - 770.21875 - 800.21875 - Ch.1156 - ABC - Statewide - VRS
Ch.225 - 770.40000 - 800.40000 - Ch.1185 ----------------
Ch.226 -
770.40625 - 800.40625 - Ch.1186 ----------------
(CRIS Site 27 Oat Mtn - Primary control channel)
Ch.227 - 770.41250 - 800.41250 - Ch.1187 - CSP(VRS) -----
Ch.228 - 770.41875 - 800.41875 - Ch.1188 - CSP(VRS) ----- [State Parks Extender]
Ch.229 - 770.42500 - 800.42500 - Ch.1189 - CHP(LMR) -----
Ch.230 - 770.43125 - 800.43125 - Ch.1190 - CHP(LMR) -----
Ch.231 - 770.43750 - 800.43750 - Ch.1191 ----------------
Ch.232 -
770.44375 - 800.44375 - Ch.1192 ----------------
(CRIS Site 30 Santiago Peak - Primary control channel)
Ch.233 - 770.45000 - 800.45000 - Ch.1193 - DOT(LMR) -----
Ch.234 - 770.45625 - 800.45625 - Ch.1194 - DOT(LMR) -----
Ch.235 - 770.46250 - 800.46250 - Ch.1195 - CDCR(LMR) ----
Ch.236 -
770.46875 - 800.46875 - Ch.1196 - CDCR(LMR) ----
(CRIS Site 24 - Rincon Peak - Alternate control channel) / [2A9 Site 1-5 Donovan CDCR Prison]
Ch.265 - 770.65000 - 800.65000 - Ch.1225 ----------------
Ch.266 -
770.65625 - 800.65625 - Ch.1226 ----------------
(CRIS Site 29 Mount Lukens) /
(CRIS Site 27 Oat Mtn - Alternate control channel)
Ch.267 - 770.66250 - 800.66250 - Ch.1227 - CHP(LMR) -----
Ch.268 - 770.66875 - 800.66875 - Ch.1228 - CHP(LMR) -----
Ch.269 - 770.67500 - 800.67500 - Ch.1229 - CSP(LMR) -----
Ch.270 - 770.68125 - 800.68125 - Ch.1230 - CSP(LMR) ----- [State Parks Ops]
Ch.271 - 770.68750 - 800.68750 - Ch.1231 - CDCR(LMR) ----
Ch.272 -
770.69375 - 800.69375 - Ch.1232 - CDCR(LMR) ----
(CRIS Site 24 - Rincon Peak - Alternate control channel)
Ch.273 - 770.70000 - 800.70000 - Ch.1233 - CDCR(LMR) ----
Ch.274 - 770.70625 - 800.70625 - Ch.1234 - CDCR(LMR) ----
Ch.275 - 770.71250 - 800.71250 - Ch.1235 - DFW(VRS) -----
Ch.276 - 770.71875 - 800.71875 - Ch.1236 - DFW(VRS) ----- [Dept Fish/Wildlife Mobile Extender Transmit]

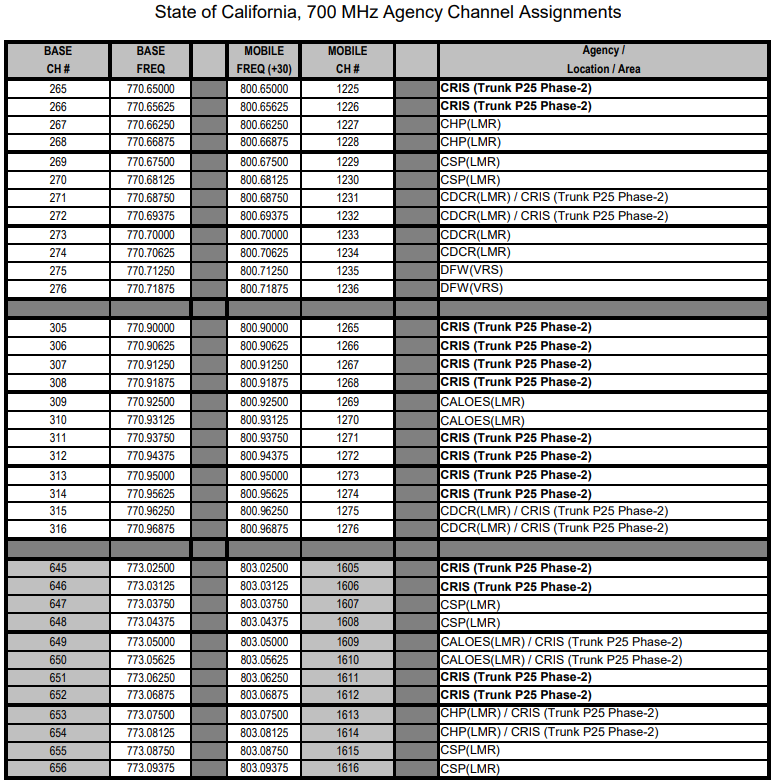

Ch.305 - 770.90000 - 800.90000 - Ch.1265 ----------------
Ch.306 - 770.90625 - 800.90625 - Ch.1266 ----------------
Ch.307 - 770.91250 - 800.91250 - Ch.1267 ----------------
Ch.308 -
770.91875 - 800.91875 - Ch.1268 ----------------
(CRIS Site 30 Santiago Peak) /
(CRIS Site 29 Mount Lukens - Alternate control channel)
Ch.309 - 770.92500 - 800.92500 - Ch.1269 - CALOES(LMR) --
Ch.310 - 770.93125 - 800.93125 - Ch.1270 - CALOES(LMR) --
Ch.311 - 770.93750 - 800.93750 - Ch.1271 ----------------
Ch.312 -
770.94375 - 800.94375 - Ch.1272 ----------------
(CRIS Site 28 - Frazier Mtn? - Alternate control channel)
Ch.313 - 770.95000 - 800.95000 - Ch.1273 ----------------
Ch.314 - 770.95625 - 800.95625 - Ch.1274 ----------------
Ch.315 - 770.96250 - 800.96250 - Ch.1275 - CDCR(LMR) ----
Ch.316 - 770.96875 - 800.96875 - Ch.1276 - CDCR(LMR) ---- [2A9 Site 1-5 Richard J. Donovan CDCR Prison]
Ch.645 - 773.02500 - 803.02500 - Ch.1605 ----------------
Ch.646 - 773.03125 - 803.03125 - Ch.1606 ----------------
Ch.647 - 773.03750 - 803.03750 - Ch.1607 - CSP(LMR) -----
Ch.648 - 773.04375 - 803.04375 - Ch.1608 - CSP(LMR) ----- [State Parks Tac2]
Ch.649 - 773.05000 - 803.05000 - Ch.1609 - CALOES(LMR) --
Ch.650 - 773.05625 - 803.05625 - Ch.1610 - CALOES(LMR) --
Ch.651 - 773.06250 - 803.06250 - Ch.1611 ----------------
Ch.652 -
773.06875 - 803.06875 - Ch.1612 ----------------
(CRIS Site 30 Santiago Peak - Alternate control channel)
Ch.653 - 773.07500 - 803.07500 - Ch.1613 - CHP(LMR) -----
Ch.654 -
773.08125 - 803.08125 - Ch.1614 - CHP(LMR) -----
(CRIS Site 25 South Mountain - Primary control channel)
Ch.655 - 773.08750 - 803.08750 - Ch.1615 - CSP(LMR) -----
Ch.656 - 773.09375 - 803.09375 - Ch.1616 - CSP(LMR) ----- [State Parks Tac1]
Ch.685 - 773.27500 - 803.27500 - Ch.1645 ----------------
Ch.686 - 773.28125 - 803.28125 - Ch.1646 ----------------
Ch.687 - 773.28750 - 803.28750 - Ch.1647 - CHP(LMR) -----
Ch.688 - 773.29375 - 803.29375 - Ch.1648 - CHP(LMR) -----
Ch.689 - 773.30000 - 803.30000 - Ch.1649 ----------------
Ch.690 -
773.30625 - 803.30625 - Ch.1650 ----------------
(CRIS Site 29 Mount Lukens) /
(CRIS Site 27 Oat Mtn - Alternate control channel)
Ch.691 - 773.31250 - 803.31250 - Ch.1651 ----------------
Ch.692 - 773.31875 - 803.31875 - Ch.1652 ----------------
Ch.693 - 773.32500 - 803.32500 - Ch.1653 - CHP(LMR) -----
Ch.694 - 773.33125 - 803.33125 - Ch.1654 - CHP(LMR) -----
Ch.695 - 773.33750 - 803.33750 - Ch.1655 ----------------
Ch.696 -
773.34375 - 803.34375 - Ch.1656 ----------------
(CRIS Site 30 Santiago Peak) /
(CRIS Site 29 Mount Lukens - Alternate control channel)
Ch.725 - 773.52500 - 803.52500 - Ch.1685 - CHP(LMR) -----
Ch.726 - 773.53125 - 803.53125 - Ch.1686 - CHP(LMR) -----
Ch.727 - 773.53750 - 803.53750 - Ch.1687 ----------------
Ch.728 -
773.54375 - 803.54375 - Ch.1688 ----------------
(CRIS Site 28 - Frazier Mtn? - Alternate control channel)
Ch.729 - 773.55000 - 803.55000 - Ch.1689 - CHP(LMR) -----
Ch.730 -
773.55625 - 803.55625 - Ch.1690 - CHP(LMR) -----
(CRIS Site 25 South Mountain - Alternate control channel)
Ch.731 - 773.56250 - 803.56250 - Ch.1691 ----------------
Ch.732 -
773.56875 - 803.56875 - Ch.1692 ----------------
(CRIS Site 30 Santiago Peak - Alternate control channel)
Ch.733 - 773.57500 - 803.57500 - Ch.1693 - CHP(LMR) -----
Ch.734 - 773.58125 - 803.58125 - Ch.1694 - CHP(LMR) -----
Ch.735 - 773.58750 - 803.58750 - Ch.1695 ----------------
Ch.736 -
773.59375 - 803.59375 - Ch.1696 ----------------
(CRIS Site 29 Mount Lukens) /
(CRIS Site 27 Oat Mtn - Alternate control channel)
Ch.765 - 773.77500 - 803.77500 - Ch.1725 - CHP(LMR) -----
Ch.766 -
773.78125 - 803.78125 - Ch.1726 - CHP(LMR) -----
(CRIS Site 25 South Mountain - Alternate control channel)
Ch.767 - 773.78750 - 803.78750 - Ch.1727 ----------------
Ch.768 -
773.79375 - 803.79375 - Ch.1728 ----------------
(CRIS Site 30 Santiago Peak) /
(CRIS Site 29 Mount Lukens - Alternate control channel)
Ch.769 - 773.80000 - 803.80000 - Ch.1729 - CHP(LMR) -----
Ch.770 - 773.80625 - 803.80625 - Ch.1730 - CHP(LMR) -----
Ch.771 - 773.81250 - 803.81250 - Ch.1731 ----------------
Ch.772 -
773.81875 - 803.81875 - Ch.1732 ----------------
(CRIS Site 28 - Frazier Mtn? - Alternate control channel)
Ch.773 - 773.82500 - 803.82500 - Ch.1733 - CHP(LMR) -----
Ch.774 - 773.83125 - 803.83125 - Ch.1734 - CHP(LMR) -----
Ch.775 - 773.83750 - 803.83750 - Ch.1735 - CDCR(LMR) ----
Ch.776 - 773.84375 - 803.84375 - Ch.1736 - CDCR(LMR) ----
Ch.805 - 774.02500 - 804.02500 - Ch.1765 ----------------
Ch.806 - 774.03125 - 804.03125 - Ch.1766 ----------------
Ch.807 - 774.03750 - 804.03750 - Ch.1767 ----------------
Ch.808 -
774.04375 - 804.04375 - Ch.1768 ----------------
(CRIS Site 29 Mount Lukens)
Ch.809 - 774.05000 - 804.05000 - Ch.1769 - CHP(LMR) -----
Ch.810 -
774.05625 - 804.05625 - Ch.1770 - CHP(LMR) -----
(CRIS Site 30 Santiago Peak - Alternate control channel)
Ch.811 - 774.06250 - 804.06250 - Ch.1771 ----------------
Ch.812 - 774.06875 - 804.06875 - Ch.1772 ----------------
Ch.813 - 774.07500 - 804.07500 - Ch.1773 - CHP(LMR) -----
Ch.814 -
774.08125 - 804.08125 - Ch.1774 - CHP(LMR) -----
(CRIS Site 27 Oat Mtn)
Ch.815 - 774.08750 - 804.08750 - Ch.1775 - CDCR(LMR) ----
Ch.816 - 774.09375 - 804.09375 - Ch.1776 - CDCR(LMR) ----
Ch.845 - 774.27500 - 804.27500 - Ch.1805 ----------------
Ch.846 - 774.28125 - 804.28125 - Ch.1806 ----------------
Ch.847 - 774.28750 - 804.28750 - Ch.1807 - CDCR(LMR) ----
Ch.848 -
774.29375 - 804.29375 - Ch.1808 - CDCR(LMR) ----
(CRIS Site 30 Santiago Peak)
Ch.849 - 774.30000 - 804.30000 - Ch.1809 - CHP(LMR) -----
Ch.850 - 774.30625 - 804.30625 - Ch.1810 - CHP(LMR) -----
Ch.851 - 774.31250 - 804.31250 - Ch.1811 ----------------
Ch.852 - 774.31875 - 804.31875 - Ch.1812 ----------------
Ch.853 - 774.32500 - 804.32500 - Ch.1813 - CHP(LMR) -----
Ch.854 -
774.33125 - 804.33125 - Ch.1814 - CHP(LMR) -----
(CRIS Site 25 South Mountain - Alternate control channel)
Ch.855 - 774.33750 - 804.33750 - Ch.1815 ----------------
Ch.856 -
774.34375 - 804.34375 - Ch.1816 ----------------
(CRIS Site 29 Mount Lukens) /
(CRIS Site 27 Oat Mtn)
Ch.885 - 774.52500 - 804.52500 - Ch.1845 - CHP(VRS) -----
Ch.886 - 774.53125 - 804.53125 - Ch.1846 - CHP(VRS) -----
Ch.887 - 774.53750 - 804.53750 - Ch.1847 ----------------
Ch.888 - 774.54375 - 804.54375 - Ch.1848 ----------------
Ch.889 - 774.55000 - 804.55000 - Ch.1849 - CHP(LMR) -----
Ch.890 - 774.55625 - 804.55625 - Ch.1850 - CHP(LMR) -----
Ch.891 - 774.56250 - 804.56250 - Ch.1851 ----------------
Ch.892 - 774.56875 - 804.56875 - Ch.1852 ----------------
Ch.893 - 774.57500 - 804.57500 - Ch.1853 - CHP(LMR) -----
Ch.894 - 774.58125 - 804.58125 - Ch.1854 - CHP(LMR) -----
Ch.895 - 774.58750 - 804.58750 - Ch.1855 - CDCR(LMR) ----
Ch.896 - 774.59375 - 804.59375 - Ch.1856 - CDCR(LMR) ---- [2A9 Site 1-5 Donovan CDCR Prison]
Ch.925 - 774.77500 - 804.77500 - Ch.1885 - CHP(LMR)
Ch.926 -
774.78125 - 804.78125 - Ch.1886 - CHP(LMR) -
(CRIS Site 29 Mount Lukens)
Ch.927 - 774.78750 - 804.78750 - Ch.1887 -
Ch.928 - 774.79375 - 804.79375 - Ch.1888 -
Ch.929 - 774.80000 - 804.80000 - Ch.1889 - CHP(LMR)
Ch.930 - 774.80625 - 804.80625 - Ch.1890 - CHP(LMR)
Ch.931 - 774.81250 - 804.81250 - Ch.1891 -
Ch.932 -
774.81875 - 804.81875 - Ch.1892 - ----------------
(CRIS Site 30 Santiago Peak)
Ch.933 - 774.82500 - 804.82500 - Ch.1893 - CHP(LMR)
Ch.934 - 774.83125 - 804.83125 - Ch.1894 - CHP(LMR)
Ch.935 - 774.83750 - 804.83750 - Ch.1895 -
Ch.936 - 774.84375 - 804.84375 - Ch.1896 -
_________________________
Scanner Programming List: - (192 Frequencies)
Code: Select all
769.15000
769.15625
769.16250
769.16875
769.17500
769.18125
769.18750
769.19375
769.20000
769.20625
769.21250
769.21875
769.40000
769.40625
769.41250
769.41875
769.42500
769.43125
769.43750
769.44375
769.45000
769.45625
769.46250
769.46875
769.65000
769.65625
769.66250
769.66875
769.67500
769.68125
769.68750
769.69375
769.70000
769.70625
769.71250
769.18750
769.90000
769.90625
769.91250
769.91875
769.92500
769.93125
769.93750
769.94375
769.95000
769.95625
769.96250
769.96875
770.15000
770.15625
770.16250
770.16875
770.17500
770.18125
770.18750
770.19375
770.20000
770.20625
770.21250
770.21875
770.40000
770.40625
770.41250
770.41875
770.42500
770.43125
770.43750
770.44375
770.45000
770.45625
770.46250
770.46875
770.65000
770.65625
770.66250
770.66875
770.67500
770.68125
770.68750
770.69375
770.70000
770.70625
770.71250
770.71875
770.90000
770.90625
770.91250
770.91875
770.92500
770.93125
770.93750
770.94375
770.95000
770.95625
770.96250
770.96875
773.02500
773.03125
773.03750
773.04375
773.05000
773.05625
773.06250
773.06875
773.07500
773.08125
773.08750
773.09375
773.27500
773.28125
773.28750
773.29375
773.30000
773.30625
773.31250
773.31875
773.32500
773.33125
773.33750
773.34375
773.52500
773.53125
773.53750
773.54375
773.55000
773.55625
773.56250
773.56875
773.57500
773.58125
773.58750
773.59375
773.77500
773.78125
773.78750
773.79375
773.80000
773.80625
773.81250
773.81875
773.82500
773.83125
773.83750
773.84375
774.02500
774.03125
774.03750
774.04375
774.05000
774.05625
774.06250
774.06875
774.07500
774.08125
774.08750
774.09375
774.27500
774.28125
774.28750
774.29375
774.30000
774.30625
774.31250
774.31875
774.32500
774.33125
774.33750
774.34375
774.52500
774.53125
774.53750
774.54375
774.55000
774.55625
774.56250
774.56875
774.57500
774.58125
774.58750
774.59375
774.77500
774.78125
774.78750
774.79375
774.80000
774.80625
774.81250
774.81875
774.82500
774.83125
774.83750
774.84375
_______________________________________________
State sites VHF licenses for Mono County / Inyo County / ALPINE County areas:
_________________________________________________
WROU856 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
12/13/2021 License Issued
SHERWIN SUMMIT, 4.8 KM SE, TOMS PLACE, CA MONO County --
(Site: 1-64)
151.0025 - FB8 -
151.2350 - FB8 -
151.4525 - FB8 -
154.1675 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4532477
https://www.radioreference.com/db/fcc/callsign/WROU856
_________________________________________________
WROV267 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
12/14/2021 License Issued
CONWAY SUMMIT RADIO SITE, 15 KM NW, LEE VINING, CA MONO County --
(Site: 1-62)
151.1450 - FB8 -
154.1825 - FB8 -
154.8150 - FB8 -
155.3250 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4533061
https://www.radioreference.com/db/fcc/callsign/WROV267
_________________________________________________
WROV271 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
12/14/2021 License Issued
CRESTVIEW RADIO SITE, 8 KM E, JUNE LAKE, CA MONO County --
(Site: 1-63)
151.2050 - FB8 -
154.2050 - FB8 -
154.7625 - FB8 -
155.1300 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4533065
https://www.radioreference.com/db/fcc/callsign/WROV271
_________________________________________________
WROY819 - CALIFORNIA, STATE OF
Radio Service: YW: Public Safety Pool, Trunked
01/03/2022 License Issued
SILVER PEAK, 19 KM NE, BISHOP, CA INYO County --
(Site: 1-65)
154.3625 - FB8 -
154.7475 - FB8 -
155.2275 - FB8 -
155.4525 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4538819
https://www.radioreference.com/db/fcc/callsign/WROY819
_________________________________________________
WRPH873 - CALIFORNIA, STATE OF
Radio Service: YW: Public Safety Pool, Trunked
02/07/2022 License Issued
SWEETWATER MOUNTAIN 16 KM NE, BRIDGEPORT, CA MONO County --
(Site: 1-61)
154.3175 - FB8 -
154.8525 - FB8 -
155.1525 - FB8 -
155.3550 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4552700
https://www.radioreference.com/db/fcc/callsign/WRPH873
_________________________________________________
WRPW349 - CALIFORNIA, STATE OF
Radio Service: YW: Public Safety Pool, Trunked
03/24/2022 License Issued
LEVIATHAN PEAK 15 KM E, MARKLEEVILLE, CA ALPINE County --
(Site: 1-60)
151.1975 - FB8 -
151.4525 - FB8 -
154.2425 - FB8 -
155.1825 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4573948
https://www.radioreference.com/db/fcc/callsign/WRPW349
_________________________________________________
WRWM655 (CALIFORNIA, STATE OF)
Radio Service: YW - Public Safety Pool, Trunked
03/08/2023 License Issued
BIG VALLEY MOUNTAIN, 5 KM SW OF, NUBIEBER, CA LASSEN County
154.0625 - FB8 -
154.3925 - FB8 -
155.0325 - FB8 -
155.2950 - FB2 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4735379
https://www.radioreference.com/db/fcc/callsign/WRWM655
_________________________________________________
WRWQ984 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
03/20/2023 License Issued
LIKELY MOUNTAIN, 6 MI SW OF LIKELY, LIKELY, CA LASSEN County
154.0475 - FB8 -
154.3625 - FB8 -
155.2575 - FB8 -
156.1425 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4740579
https://www.radioreference.com/db/fcc/callsign/WRWQ984
_________________________________________________
WRWX353 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
04/07/2023 License Issued
CAHTO PEAK, 8 KM WEST OF, LAYTONVILLE, CA MENDOCINO County
151.1300 - FB8 -
155.2350 - FB2 -
155.4450 - FB8 -
156.0600 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4749972
https://www.radioreference.com/db/fcc/callsign/WRWX353
_________________________________________________
WRWY413 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
04/11/2023 License Issued
SHAFFER MOUNTAIN, 26 KM EAST OF, SUSANVILLE, CA LASSEN County
154.4075
155.2425
155.4900
155.8125
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4751570
https://www.radioreference.com/db/fcc/callsign/WRWY413
_________________________________________________
WRXN540 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
06/02/2023 License Issued
HATCHET MOUNTAIN, 8 KM WEST OF, BURNEY, CA SHASTA County
154.7550 - FB8 -
154.9650 - FB8 -
155.4375 - FB8 -
155.9625 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4774615
https://www.radioreference.com/db/fcc/callsign/WRXN540
_________________________________________________
WRXS988 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
06/26/2023 License Issued
PRATT MOUNTAIN, 8 KM EAST OF, GARBERVILLE, CA HUMBOLDT County
154.6650 - FB8 -
155.2050 - FB2 -
155.4900 - FB8 -
155.9625 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4781308
https://www.radioreference.com/db/fcc/callsign/WRXS988
_________________________________________________
WRXX326 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
07/07/2023 License Issued
LAUGHLIN RIDGE, 26 KM EAST OF, WILLITS, CA MENDOCINO County
151.2050 - FB8 -
154.6725 - FB8 -
154.9050 - FB8 -
155.5125 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4787502
https://www.radioreference.com/db/fcc/callsign/WRXX326
_________________________________________________
WRYB455 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
07/19/2023 License Issued
HORSE MOUNTAIN, 13 SW OF, WILLOW CREEK, CA HUMBOLDT County
151.2125 - FB8 -
151.4300 - FB8 -
154.7250 - FB8 -
155.3250 - FB2 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4793144
https://www.radioreference.com/db/fcc/callsign/WRYB455
_________________________________________________
WRYB456 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
07/19/2023 License Issued
HOADLEY PEAK, 9.6 KM WEST OF, FRENCH GULCH, CA SHASTA County
154.7025 - FB8 -
154.9425 - FB8 -
155.4600 - FB8 -
155.6550 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4793145
https://www.radioreference.com/db/fcc/callsign/WRYB456
_________________________________________________
WRYB458 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
07/19/2023 License Issued
ANTELOPE MOUNTAIN, 8 KM FROM JCT 120 AND BENTON CROSSING, BENTON, CA MONO County
151.2875 - FB8 -
154.6800 - FB8 -
155.5200 - FB8 -
155.8425 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4793147
https://www.radioreference.com/db/fcc/callsign/WRYB458
_________________________________________________
WRYB459 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
07/19/2023 License Issued
COLD SPRINGS MTN, 9 KM SW OF, PHILO, CA MENDOCINO County
151.1750 - FB8 -
155.0850 - FB8 -
155.3025 - FB8 -
155.5875 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4793148
https://www.radioreference.com/db/fcc/callsign/WRYB459
_________________________________________________
WRYE371 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
07/31/2023 License Issued
ROGERS PEAK, 58 KM SW OF, DEATH VALLEY, CA INYO County
151.0100 - FB8 -
155.9400 - FB8 -
155.9625 - FB8 -
156.2400 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4797145
https://www.radioreference.com/db/fcc/callsign/WRYE371
_________________________________________________
WRYZ590 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
10/06/2023 License Issued
COTTONWOOD RADIO SITE, 15 KM SOUTH OF, LONE PINE, CA INYO County
154.0475 - FB8 -
154.7025 - FB8 -
155.1975 - FB8 -
155.7075 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4826018
https://www.radioreference.com/db/fcc/callsign/WRYZ590
_________________________________________________
WRZR822 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
12/04/2023 License Issued
BLACK MOUNTAIN, 7 KM SOUTHEAST OF, MILFORD, CA LASSEN County
154.0925 - FB8 -
154.6650 - FB8 -
155.2275 - FB8 -
155.7900 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4850098
https://www.radioreference.com/db/fcc/callsign/WRZR822
_________________________________________________
WRZR823 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
12/04/2023 License Issued
OAK RIDGE - 25555 KELLY ROAD, ANNAPOLIS, CA SONOMA County
154.6950 - FB8 -
154.9350 - FB8 -
155.2800 - FB8 -
155.6625 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4850099
https://www.radioreference.com/db/fcc/callsign/WRZR823
_________________________________________________
WRZR824 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
12/04/2023 License Issued
ANTELOPE VALLEY FS1, 1166 LARSON LANE, COLEVILLE, CA MONO County
154.2125 - FB8 -
154.6950 - FB8 -
155.4075 - FB8 -
156.1200 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4850100
https://www.radioreference.com/db/fcc/callsign/WRZR824
_________________________________________________
WRZR825 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
12/04/2023 License Issued
RUBY BLUFF, 3.5 MI SOUTH, DOWNIEVILLE, CA SIERRA County
151.4150 - FB8 -
154.6800 - FB8 -
154.8600 - FB8 -
155.6475 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4850101
https://www.radioreference.com/db/fcc/callsign/WRZR825
_________________________________________________
WRZR827 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
12/04/2023 License Issued
MAMMOTH LAKE FS1, 3150 MAIN STREET, MAMMOTH LAKES, CA MONO County
151.1000 - FB8 -
155.1675 - FB8 -
155.7225 - FB8 -
156.1050 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4850103
https://www.radioreference.com/db/fcc/callsign/WRZR827
_________________________________________________
WSAX632 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
02/21/2024 License Issued
MAMMOTH LINCOLN MTN, 4 KM SW OF MAMMOTH LAKES, MAMMOTH LAKES, CA MONO County
154.2275
154.7025
155.4300
155.6775
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4890204
https://www.radioreference.com/db/fcc/callsign/WSAX632
_________________________________________________
WSBY313 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
03/19/2024 License Issued
RED HILL, 6 KM NE, BELDEN, CA PLUMAS County
154.3175 - FB8 -
154.9350 - FB8 -
155.0175 - FB8 -
155.6625 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4917988
https://www.radioreference.com/db/fcc/callsign/WSBY313
_________________________________________________
WSCA402 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
03/25/2024 License Issued
JUNE MTN CHALET, 3819 HWY 158, JUNE LAKE, CA MONO County
154.0400 - FB8 -
154.6650 - FB8 -
154.9725 - FB8 -
155.8275 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4920843
https://www.radioreference.com/db/fcc/callsign/WSCA402
_________________________________________________
WSCA441 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
03/25/2024 License Issued
PEAVINE RIDGE 13 MILES NW, RENO, NV WASHOE County
154.8075 - FB8 -
155.2875 - FB8 -
155.4900 - FB8 -
155.7000 - FB8 -
The state will use a corner reflector antenna to provide coverage to the desired area.
The antenna model is SV227-SF1SNM with an antenna gain of 7 dB and azimuth of 270°
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4920882
https://www.radioreference.com/db/fcc/callsign/WSCA441
_________________________________________________
WSDG621 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
06/10/2024 License Issued
HOWELL MTN LOOKOUT, 2.5 MI SW OF, COLFAX, CA PLACER County
151.0775 - FB8 -
154.0925 - FB8 -
154.3700 - FB8 -
155.4675 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4964395
https://www.radioreference.com/db/fcc/callsign/WSDG621
_________________________________________________
WSEB752 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
08/06/2024 License Issued
SUGARLOAF MTN, 3 KM SOUTH OF, DELTA, CA SHASTA County
151.0925 - FB8 -
155.2500 - FB8 -
155.4975 - FB8 -
155.8650 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4991786
https://www.radioreference.com/db/fcc/callsign/WSEB752
_________________________________________________
WSEC898 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
08/08/2024 License Issued
OREGON PEAK, 3 KM NE OF, DOBBINS, CA YUBA County
151.0400 - FB8 -
154.0325 - FB8 -
154.7025 - FB8 -
155.0475 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4993885
https://www.radioreference.com/db/fcc/callsign/WSEC898
_________________________________________________
WSEC940 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
08/08/2024 License Issued
EAST BRISTOL MOUNTAIN - CHP EAST BRISTOL2, 6 KM NE OF, AMBOY, CA SAN BERNARDINO County
151.3100 - FB8 -
154.8600 - FB8 -
155.6700 - FB8 -
156.1125 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4993929
https://www.radioreference.com/db/fcc/callsign/WSEC940
_________________________________________________
WSED418 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
08/09/2024 License Issued
SLATER BUTTE, 8 KM NORTH OF, HAPPY CAMP, CA SISKIYOU County
151.0400
154.2125
154.9125
155.2275
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=4994405
https://www.radioreference.com/db/fcc/callsign/WSED418
_________________________________________________
WSEM882 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
09/05/2024 License Issued
GUNSIGHT PEAK, 11 KM WEST OF, YREKA, CA SISKIYOU County
154.9350 - FB8 -
155.1525 - FB8 -
155.3625 - FB8 -
155.7375 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5007072
https://www.radioreference.com/db/fcc/callsign/WSEM882
_________________________________________________
WSEN646 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
09/09/2024 License Issued
MOUNT HAMAKER, 24 KM SW, KLAMATH FALLS, OR KLAMATH County
154.2275 - FB8 -
154.8825 - FB8 -
155.5050 - FB8 -
155.8425 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5008072
https://www.radioreference.com/db/fcc/callsign/WSEN646
_________________________________________________
WSEV735 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
09/30/2024 License Issued
MOUNT PIERCE, 10 KM S, RIO DELL, CA HUMBOLDT County
151.2350 - FB8 -
151.4600 - FB8 -
154.8825 - FB8 -
155.7300 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5017502
https://www.radioreference.com/db/fcc/callsign/WSEV735
_________________________________________________
WSFP808 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
10/31/2024 License Issued / (Modified on 9/09/2025)
SOUTH FORK MTN LOOKOUT, 15KM WEST OF, REDDING, CA SHASTA County
151.1300 - FB8 -
154.6725 - FB8 -
155.3775 - FB8 -
155.9025 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5039968
https://www.radioreference.com/db/fcc/callsign/WSFP808
_________________________________________________
WSGS864 - CALIFORNIA, STATE OF
Radio Service
YW - Public Safety Pool, Trunked
01/17/2025 License Issued
SODA RIDGE, 2 KM EAST
DUNSMUIR, CA SISKIYOU County
151.0775 - FB8 -
155.2350 - FB2 -
155.5425 - FB8 -
155.8200 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5078435
https://www.radioreference.com/db/fcc/callsign/WSGS864
_________________________________________________
WSHN703 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
03/18/2025 License Issued
SEIGLER MTN, 6 KM NORTH OF, COBB, CA LAKE County
154.3325 - FB8 -
155.1825 - FB8 -
155.3925 - FB8 -
155.6025 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5108581
https://www.radioreference.com/db/fcc/callsign/WSHN703
_________________________________________________
WSHN707 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
03/18/2025 License Issued
SEAVIEW RIDGE SITE, 10 KM NW, JENNER, CA SONOMA County
154.0475 - FB8 -
154.3475 - FB8 -
154.8225 - FB8 -
155.2425 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5108585
https://www.radioreference.com/db/fcc/callsign/WSHN703
_________________________________________________
WSHP244 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
03/19/2025 License Issued
COLBY MOUNTAIN 8 KM N, BUTTE MEADOWS, CA TEHAMA County
151.4750 - FB8 -
155.0175 - FB8 -
155.8875 - FB8 -
156.2325 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5109319
https://www.radioreference.com/db/fcc/callsign/WSHP244
_______________________________________
WSII219 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
05/19/2025 License Issued / (Modified on 9/10/2025)
PLATTE MOUNTAIN, 6.4 KM NE, FOREST RANCH, CA BUTTE County
151.2050 - FB8 -
154.7025 - FB8 -
155.0325 - FB8 -
155.4450 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5137977
https://www.radioreference.com/db/fcc/callsign/WSII219
_______________________________________
WSJR702 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
08/19/2025 License Issued
ANTELOPE PEAK, 10KM SW OF, GRENADA, CA SISKIYOU County
151.0025 - FB8 -
151.2350 - FB2 -
154.6650 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5185741
https://www.radioreference.com/db/fcc/callsign/WSJR702
_______________________________________
WSJV269 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
08/28/2025 License Issued
MOUNT ZION, 1 KM SOUTH OF, PINE GROVE, CA AMADOR County
154.9425 - FB8 -
155.4975 - FB8 -
155.8875 - FB8 -
156.2100 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5190101
https://www.radioreference.com/db/fcc/callsign/WSJV269
_______________________________________
WSKF912 - CALIFORNIA, STATE OF
Radio Service: YW - Public Safety Pool, Trunked
09/29/2025 License Issued
BLOOMER HILL, 16 KM NE OF, OROVILLE, CA BUTTE County
154.7625 - FB8 -
155.2350 - FB8 -
155.4975 - FB8 -
155.8800 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5205073
https://www.radioreference.com/db/fcc/callsign/WSKF912
_______________________________________
WSMC627 - CALIFORNIA, STATE OF
03/18/2026 License Issued
UNION HILL, 2.9 KM EAST OF, POLLOCK PINES, CA EL DORADO County
151.2275 - FB8 -
155.5350 - FB8 -
155.7225 - FB8 -
156.1875 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5271950
https://www.radioreference.com/db/fcc/callsign/WSMC627
_______________________________________
WSMX771 - CALIFORNIA, STATE OF
05/21/2026 License Issued
Radio Service: YW - Public Safety Pool, Trunked
LEEK SPRING HILL, 16 KM SOUTH OF, KYBURZ, CA EL DORADO County
154.0850 - FB8 -
154.6875 - FB8 -
154.9425 - FB8 -
155.4525 - FB8 -
https://wireless2.fcc.gov/UlsApp/UlsSea ... ey=5308165
https://www.radioreference.com/db/fcc/callsign/WSMX771
_______________________________________

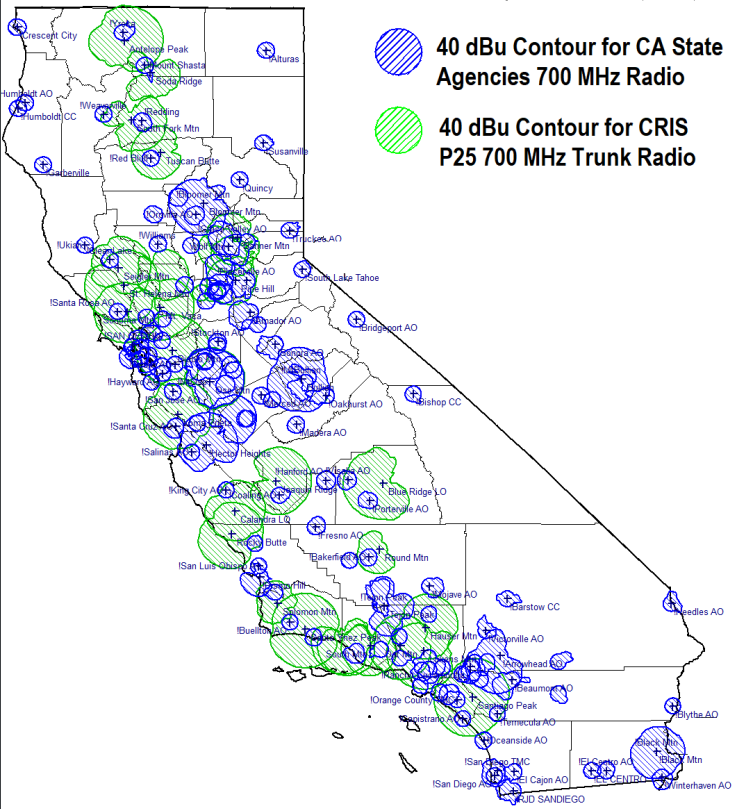

- California-CRIS-P25-Map-2022.png (297.3 KiB) Viewed 323523 times

- California-700MHz-Channel-Assignments-1.png (137.08 KiB) Viewed 323521 times

- California-700MHz-Channel-Assignments-2.png (161.63 KiB) Viewed 323521 times

- California-700MHz-Channel-Assignments-3.png (168.27 KiB) Viewed 323521 times

- California-700MHz-Channel-Assignments-4.png (184.48 KiB) Viewed 323521 times

- California-700MHz-Channel-Assignments-5.png (181.2 KiB) Viewed 323521 times

- California-700MHz-Channel-Assignments-6.png (73.45 KiB) Viewed 323521 times

- CRIS-Deployment of CRIS VHF-Sites.png (212.05 KiB) Viewed 322334 times

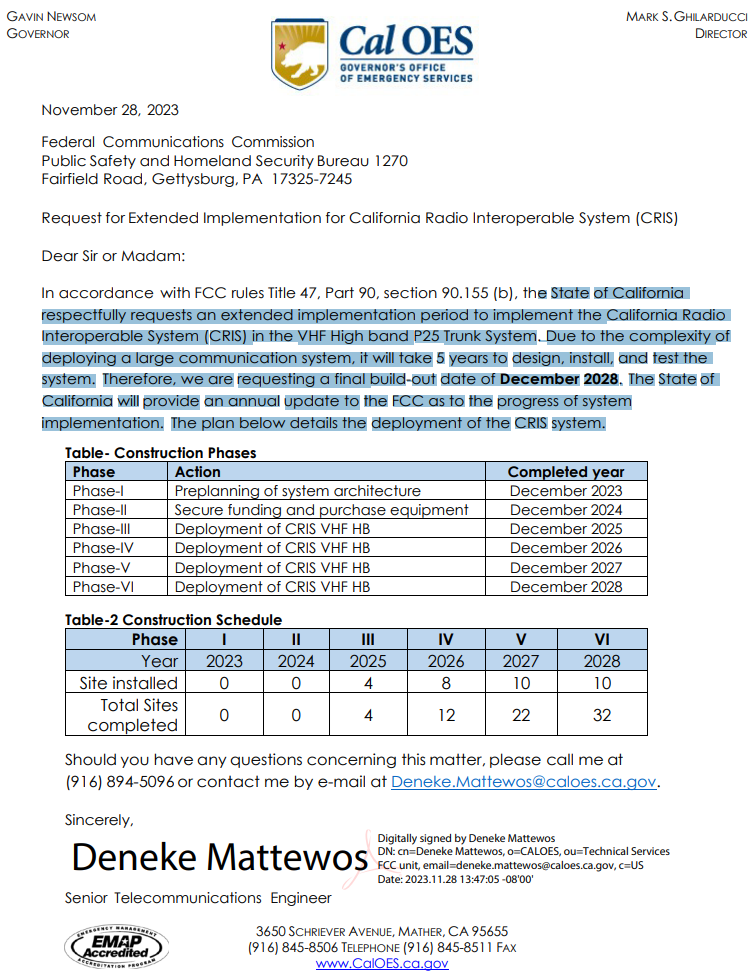

- CRIS-to-FCC-Construction-Schedule-Letter-November-28-2023.png (293.54 KiB) Viewed 321255 times
Re: California Radio Interoperable System (CRIS) - San Diego County Area Sites in 2022
Posted: Sun Nov 28, 2021 2:16 pm
by Brian
CRIS Sites Pro96Com Reports:
Reminder: Please do not submit, or share the info with RadioReference
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-13 - Mt. Saint Helena, Sonoma County
Tower Number (Hex) : T010D
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Fri Apr 1 00:46:27 2022
Site NAC: 9DD
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1312","c",770.20625,"01-1312",800.20625,0,0
"01-1430","a",770.94375,"01-1430",800.94375,0,0
"01-1846","a",773.54375,"01-1846",803.54375,0,0
"01-1890","a",773.81875,"01-1890",803.81875,1,0
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-15 - Mt. Vaca, Solano County
Tower Number (Hex) : T010F
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Fri Apr 1 00:14:03 2022
Site NAC:9DF
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1768","c",773.05625,"01-1768",803.05625,0,0
"01-1806","a",773.29375,"01-1806",803.29375,0,0
"01-1852","a",773.58125,"01-1852",803.58125,0,0
"01-1888","a",773.80625,"01-1888",803.80625,1,0
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-18 - Mt. Diablo, Contra Costa County
Tower Number (Hex) : T0112
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Fri Apr 1 00:03:09 2022
Site NAC: 9D8
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1350","c",770.44375,"01-1350",800.44375,0,0
"01-1770","a",773.06875,"01-1770",803.06875,0,0
"01-1850","a",773.56875,"01-1850",803.56875,0,0
"01-1928","a",774.05625,"01-1928",804.05625,0,0
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-20 - Loma Prieta, Santa Clara County
Tower Number (Hex) : T0114
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Wed Mar 30 07:41:27 2022
Site NAC: 9D0
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1184","c",769.40625,"01-1184",799.40625,0,0
"01-1384","a",770.65625,"01-1384",800.65625,0,0
"01-1808","a",773.30625,"01-1808",803.30625,1,0
"01-1854","a",773.59375,"01-1854",803.59375,1,0
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-24 - Rincon Peak, Ventura County
Tower Number (Hex) : T0118
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Tue Mar 29 07:43:11 2022
Site NAC: 9D4
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1264","c",769.90625,"01-1264",799.90625,0,0
"01-1306","a",770.16875,"01-1306",800.16875,0,0
"01-1354","a",770.46875,"01-1354",800.46875,0,0
"01-1390","a",770.69375,"01-1390",800.69375,1,0
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-25 - South Mountain, Ventura County
Tower Number (Hex) : T0119
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Tue Mar 29 18:23:39 2022
Site NAC: 9D5
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1772","c",773.08125,"01-1772",803.08125,0,0
"01-1848","a",773.55625,"01-1848",803.55625,0,0
"01-1884","a",773.78125,"01-1884",803.78125,0,0
"01-1972","a",774.33125,"01-1972",804.33125,1,0
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-27 - Oat Mountain, Los Angeles County
Tower Number (Hex) : T011B
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Tue Mar 29 18:25:43 2022
Site NAC: 9D7
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1184","c",769.40625,"01-1184",799.40625,0,0
"01-1384","a",770.65625,"01-1384",800.65625,0,0
"01-1808","a",773.30625,"01-1808",803.30625,0,0
"01-1854","a",773.59375,"01-1854",803.59375,1,0
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-29 - Mount Lukens, Los Angeles County
Tower Number (Hex) : T011D
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Mon Mar 28 22:37:10 2022
Site NAC: 9D9
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1274","c",769.96875,"01-1274",799.96875,0,0
"01-1426","a",770.91875,"01-1426",800.91875,0,0
"01-1814","a",773.34375,"01-1814",803.34375,0,0
"01-1886","a",773.79375,"01-1886",0.00000,1,0
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-38 - ? - Santa Barbara County
Tower Number (Hex) : T0126
Control Capabilities : Voice,Registration
Flavor : Phase 2
Timestamp : Tue Mar 29 22:37:24 2022
Site NAC: 9D8
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1312","c",770.20625,"01-1312",800.20625,0,0
"01-1430","a",770.94375,"01-1430",800.94375,0,0
"01-1846","a",773.54375,"01-1846",803.54375,0,0
"01-1890","a",773.81875,"01-1890",803.81875,1,0
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-39 - ? - Santa Barbara County
Tower Number (Hex) : T0127
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Tue Mar 29 22:51:32 2022
Site NAC: 9D9
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1184","c",769.40625,"01-1184",799.40625,0,0
"01-1384","a",770.65625,"01-1384",800.65625,0,0
"01-1808","a",773.30625,"01-1808",803.30625,0,0
"01-1854","a",773.59375,"01-1854",803.59375,1,0
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-40 - Santa Ynez Peak?, Santa Barbara County
Tower Number (Hex) : T0128
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Tue Mar 29 18:29:01 2022
Site NAC:
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1350","c",770.44375,"01-1350",800.44375,0,0
"01-1770","a",773.06875,"01-1770",803.06875,0,0
"01-1850","a",773.56875,"01-1850",803.56875,0,0
"01-1928","a",774.05625,"01-1928",804.05625,0,0
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-51 - Red Mountain?, Ventura County
Tower Number (Hex) : T0133
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : CHANGEME
Timestamp : Tue Mar 29 13:25:05 2022
Site NAC: 9D1
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1768","c",773.05625,"01-1768",803.05625,0,0
"01-1806","a",773.29375,"01-1806",803.29375,0,0
"01-1852","a",773.58125,"01-1852",803.58125,0,0
"01-1888","a",773.80625,"01-1888",803.80625,1,0
"01-2048","i",774.80625,"01-2048",804.80625,0,1
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-53 - Mt. Lowe?, San Luis Obispo County
Tower Number (Hex) : T0135
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Wed Mar 30 02:53:22 2022
Site NAC: 9D3
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1274","c",769.96875,"01-1274",799.96875,0,0
"01-1426","a",770.91875,"01-1426",800.91875,0,0
"01-1814","a",773.34375,"01-1814",803.34375,0,0
"01-1886","a",773.79375,"01-1886",803.79375,1,0
___________________________________________________________
___________________________________________________________
Re: California Radio Interoperable System (CRIS) - 9D2 - San Diego County Area Sites in 2022
Posted: Fri Jul 08, 2022 3:41 am
by Brian
_______________________________________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-16 - Bay Area
Tower Number (Hex) : T0110
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Thu Sep 8, 2022
Site NAC: 9D0
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1772","c",773.08125,"01-1772",803.08125,0,0
"01-1848","a",773.55625,"01-1848",803.55625,0,0
"01-1884","a",773.78125,"01-1884",803.78125,1,0
"01-1972","a",774.33125,"01-1972",804.33125,0,0
__________________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-50 - Seigler Mountain, Lake
Tower Number (Hex) : T0132
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Thu Sep 8, 2022
Site NAC: 9DC
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1184","c",769.40625,"01-1184",799.40625,0,0
"01-1384","a",770.65625,"01-1384",800.65625,0,0
"01-1808","a",773.30625,"01-1808",803.30625,0,0
"01-1854","a",773.59375,"01-1854",803.59375,1,0
_____________________________________________
Reminder: Please do not submit, or share the info with RadioReference
CRIS sites in Placerville, California
Posted: Mon May 01, 2023 8:37 pm
by Brian
Logged from hotel in Placerville, California
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-1 Pine Hill - El Dorado
Tower Number (Hex) : T0101
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Mon May 1 21:32:09 2023
SiteNAC: 9D1
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1184","c",769.40625,"01-1184",799.40625,0,0
"01-1384","a",770.65625,"01-1384",800.65625,0,0
"01-1808","a",773.30625,"01-1808",803.30625,1,0
"01-1854","a",773.59375,"01-1854",803.59375,0,0
"01-1932","vd",774.08125,"01-1932",804.08125,0,5
"01-1974","i",774.34375,"01-1974",804.34375,0,1
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
107,"T0107",9d2,"01-1152",769.20625
121,"T0115",9d2,"01-1772",773.08125
123,"T0117",9d2,"01-1768",773.05625
166,"T0142",9d2,"01-1312",770.20625
____________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-21 - Wolf Mountain - Nevada County
Tower Number (Hex) : T0115
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Tue May 2 08:30:46 2023
SiteNAC: 9D1
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1772","c",773.08125,"01-1772",803.08125,0,0
"01-1848","a",773.55625,"01-1848",803.55625,0,0
"01-1884","a",773.78125,"01-1884",803.78125,0,0
"01-1972","a",774.33125,"01-1972",804.33125,0,0
"01-2008","v",774.55625,"01-2008",804.55625,0,1
"01-2052","i",774.83125,"01-2052",804.83125,1,4
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
101,"T0101",9d2,"01-1184",769.40625
107,"T0107",9d2,"01-1152",769.20625
108,"T0108",9d2,"01-1264",769.90625
109,"T0109",9d2,"01-1312",770.20625
122,"T0116",9d2,"01-1274",769.96875
123,"T0117",9d2,"01-1768",773.05625
CRIS Logs from May,2023 Trip
Posted: Wed Sep 27, 2023 11:12 am
by Brian
Logs from May,2023 Trip
____________________________________________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-20 - (Loma Prieta, Santa Clara)
Tower Number (Hex) : T0114
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Mon May 22 15:35:54 2023
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1184","c",769.40625,"01-1184",799.40625,0,0
"01-1384","a",770.65625,"01-1384",800.65625,0,0
"01-1808","a",773.30625,"01-1808",803.30625,0,0
"01-1854","a",773.59375,"01-1854",0.00000,1,0
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
118,"T0112",9d2,"01-1350",770.44375
119,"T0113",9d2,"01-1312",770.20625
____________________________________________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-24 - (Rincon Peak, Ventura)
Tower Number (Hex) : T0118
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Mon May 22 10:58:59 2023
SiteNAC: 9D4
5/22/2023 10:57 Station ID 01-1894 773.84375 WPTZ774
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1264","c",769.90625,"01-1264",799.90625,0,0
"01-1306","a",770.16875,"01-1306",800.16875,0,0
"01-1354","a",770.46875,"01-1354",800.46875,0,0
"01-1390","a",770.69375,"01-1390",800.69375,0,0
"01-1894","i",773.84375,"01-1894",803.84375,0,1
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
125,"T0119",9d2,"01-1772",773.08125
140,"T0128",9d2,"01-1350",770.44375
151,"T0133",9d2,"01-1768",773.05625
____________________________________________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-25 - (South Mountain, Ventura)
Tower Number (Hex) : T0119
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Mon May 22 09:58:31 2023
SiteNAC: 9D5
5/22/2023 9:57 Station ID Jan-52 774.83125 WPTZ774
5/22/2023 9:58 Station ID Jan-52 774.83125 WPTZ774
5/22/2023 9:58 Station ID Jan-52 774.83125 WPTZ774
5/22/2023 9:58 Station ID Jan-52 774.83125 WPTZ774
5/22/2023 9:58 Station ID Jan-52 774.83125 WPTZ774
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1772","c",773.08125,"01-1772",803.08125,0,0
"01-1848","a",773.55625,"01-1848",803.55625,0,0
"01-1884","a",773.78125,"01-1884",803.78125,1,0
"01-1972","a",774.33125,"01-1972",804.33125,1,0
"01-2052","i",774.83125,"01-2052",804.83125,0,5
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
124,"T0118",9d2,"01-1264",769.90625
126,"T011A",9d2,"01-1152",769.20625
127,"T011B",9d2,"01-1184",769.40625
128,"T011C",9d2,"01-1312",770.20625
151,"T0133",9d2,"01-1768",773.05625
____________________________________________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-39 - (Mt. Solomon, Santa Barbara)
Tower Number (Hex) : T0127
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Mon May 22 11:58:40 2023
SiteNAC: 9D9
5/22/2023 11:57 Station ID Jan-74 774.34375 WPTZ774
5/22/2023 11:58 Station ID Jan-74 774.34375 WPTZ774
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1184","c",769.40625,"01-1184",799.40625,0,0
"01-1384","a",770.65625,"01-1384",800.65625,0,0
"01-1808","a",773.30625,"01-1808",803.30625,0,0
"01-1854","a",773.59375,"01-1854",0.00000,1,0
"01-1974","i",774.34375,"01-1974",804.34375,0,2
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
136,"T0124",9d2,"01-1772",773.08125
140,"T0128",9d2,"01-1350",770.44375
153,"T0135",9d2,"01-1264",769.90625
____________________________________________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-40 - (Santa Ynez Peak, Santa Barbara)
Tower Number (Hex) : T0128
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Mon May 22 10:42:47 2023
SiteNAC: 9D0
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1350","c",770.44375,"01-1350",800.44375,0,0
"01-1770","a",773.06875,"01-1770",803.06875,0,0
"01-1850","a",773.56875,"01-1850",0.00000,1,0
"01-1928","a",774.05625,"01-1928",0.00000,1,0
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
124,"T0118",9d2,"01-1264",769.90625
139,"T0127",9d2,"01-1184",769.40625
151,"T0133",9d2,"01-1768",773.05625
____________________________________________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-51 - (Red Mountain, Ventura)
Tower Number (Hex) : T0133
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Mon May 22 10:34:58 2023
SiteNAC: 9D1
-Tables
#Format: Table ID,Base Freq,Spacing,Input Offset,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1768","c",773.05625,"01-1768",803.05625,0,0
"01-1806","a",773.29375,"01-1806",803.29375,0,0
"01-1852","a",773.58125,"01-1852",803.58125,0,0
"01-1888","a",773.80625,"01-1888",0.00000,1,0
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
124,"T0118",9d2,"01-1264",769.90625
125,"T0119",9d2,"01-1772",773.08125
140,"T0128",9d2,"01-1350",770.44375
____________________________________________________________________________________________
____________________________________________________________________________________________
____________________________________________________________________________________________
_______________________________________________
_____________________________________________________
Sites: - Site NACs: - Primary Control Channel:
1-1 - 9D1 - 769.40625 - Pine Hill, El Dorado
1-2 - 9D2 - 769.96875 - Mt. Oso, Stanislaus
1-3 - 9D3 - - Mt. Bullion, Mariposa
1-4 - 9D4 - - Blue Ridge, Tulare
1-5 - 9D5 - - Joaquin Ridge, Fresno
1-6 - 9D6 - - Round Mountain, Kern
1-7 - 9D7 - 769.20625 - Downtown Sacramento, Sacramento
1-8 - 9D8 - 769.90625 - Bald Mountain, Yolo
1-9 - 9D9 - 770.20625 - Bloomer Hill, Butte
1-10 - 9DA - - Tuscan Butte, Tehama
1-11 - 9DB - - South Fork Mountain, Shasta
1-12 - 9DC - 773.05625 - Strawberry Peak, San Bernardino
1-13 - 9DD - 770.20625 - Mt. Saint Helena, Sonoma County
1-14 - 9DE - 769.96875 - English Hill, Sonoma
1-15 - 9DF - 773.05625 - Mt. Vaca, Solano County
1-16 - 9D0 - 773.08125 - Sonoma Mountain, Sonoma
1-17 - 9DA - - Mt Tam Middle Peak, Marin
1-18 - 9D8 - 770.44375 - Mt. Diablo, Contra Costa
1-19 -9D9 - 770.20625 - Sunol Ridge, Alameda
1-20 - 9D0 - 769.40625 - Loma Prieta, Santa Clara County
1-21 - 9D1 - 773.08125 - Wolf Mountain, Nevada
1-22 - 9D2 - 769.96875 - Banner Mountain, Nevada
1-23 - 9D3 - 773.05625 - Mount Howell, Placer
1-24 - 9D4 - 769.90625 - Rincon Peak, Ventura
1-25 - 9D5 - 773.08125 - South Mountain, Ventura
1-26 - 9D6 - 769.20625 - Tejon Peak, Los Angeles
1-27 - 9D7 - 769.40625 - Oat Mountain, Los Angeles
1-28 - 9D8 - 770.94375 - Hauser Peak, Los Angeles
1-29 - 9D9 - 773.34375 - Mt. Lukens, Los Angeles
1-30 - 9D0 - 773.56875 - Santiago Peak, Riverside
1-31 - 9D1 - - Blue Canyon, Placer
1-32 - 9D2 - - Cisco Butte, Placer
1-33 - 9D3 - - Donner Beacon, Nevada
1-35 - 9D5 - - Fremont Peak, Monterey
1-36 - 9D6 - 773.08125 - Calandra (Williams Hill), Monterey
1-37 - - - Mt. Lowe, San Luis Obispo
1-38 - 9D8 - 770.20625 - Plowshare Peak, Santa Barbara
1-39 - 9D9 - 769.40625 - Mt. Solomon, Santa Barbara
1-40 - 9D0 - 770.44375 - Santa Ynez Peak, Santa Barbara
1-41 - 9D1 - - Sugarloaf Mountain, Shasta
1-42 - 9D2 - - Soda Ridge, Siskiyou
1-43 - 9D3 - - Antelope Mountain, Siskiyou
1-47 - 9D7 - 773.80625 - Cuyamaca Peak, San Diego
1-48 - 9D8 - 773.30625 - Red Mountain (Fallbrook), San Diego
1-50 - 9DC - 769.40625 - Seigler Mountain, Lake
1-51 - 9D1 - 773.05625 - Red Mountain, Ventura
1-53 - 9D3 - 769.90625 - Rocky Butte, San Luis Obispo
1-54 - 9D4 - 769.96875 - Mt. Woodson, San Diego
1-56 - 9D6 - 769.40625 - Chuckwalla Mtn, Riverside County
1-58 - 9D8 - 774.33125 - Rodman Mtn, San Bernardino, County
1-59 - 9D9 - 773.06875 - Government Peak, Kern
1-60 - 9D0 - - Leviathan Peak, Alpine - (VHF)
1-61 - 9D1 - - Sweetwater Mountain, Mono - (VHF)
1-62 - 9D2 - - Conway Summit, Mono - (VHF)
1-63 - 9D3 - - Crestview, Mono - (VHF)
1-64 - 9D4 - - Sherwin Summit, Mono - (VHF)
1-65 - 9D5 - - Silver Peak, Inyo - (VHF)
1-66 - 9D6 - 770.20625 - Mather Cal OES, Sacramento
1-67 - 9D7 - 770.40625 - Toro Peak, Riverside
1-69 - 9D9 - - Mammoth Lakes FS1, Mono
1-74 - 9D4 - 769.90625 - Deadwood Peak, Madera
1-76 - 9D6 - - Laughlin Ridge, Mendocino
1-77 - 9D7 - - Cahto Peak, Mendocino
1-78 - 9D1 - - Pratt Mountain, Humboldt
1-79 - 9D9 - - Mt. Pierce, Humboldt
1-80 - 9D0 - - Horse Mountain, Humboldt
1-81 - - Cold Springs Mountain, Mendocino
1-83 - 9D3 - - Big Valley Mountain, Lassen
1-84 - 9D4 - - Mountain,Lassen
1-85 - 9D5 - - Shaffer Mountain, Lassen
1-86 - 9D6 - - Hoadley Peak, Shasta
1-87 - 9D7 - - Hatchet Mountain, Shasta
1-104 - 9D4 - - Call Mountain, San Benito
_______________________________________________
__________________________________________________
Sites Primary Control Channel - Sorted by Frequencies:
1-7 - 769.20625 - Downtown Sacramento, Sacramento
1-26 - 769.20625 - Tejon Peak, Los Angeles
__________________________________________________
1-1 - 769.40625 - Pine Hill, El Dorado
1-20 - 769.40625 - Loma Prieta, Santa Clara County
1-27 - 769.40625 - Oat Mountain, Los Angeles
1-39 - 769.40625 - Mt. Solomon, Santa Barbara
1-50 - 769.40625 - Seigler Mountain, Lake
1-56 - 769.40625 - Chuckwalla Mtn, Riverside County
__________________________________________________
1-8 - 769.90625 - Bald Mountain, Yolo
1-24 - 769.90625 - Rincon Peak, Ventura
1-53 - 769.90625 - Rocky Butte, San Luis Obispo
1-74 - 769.90625 - Deadwood Peak, Madera
__________________________________________________
1-2 - 769.96875 - Mt. Oso, Stanislaus
1-14 - 769.96875 - English Hill, Sonoma
1-22 - 769.96875 - Banner Mountain, Nevada
1-29 - 769.96875 - Mt. Lukens, Los Angeles
1-54 - 769.96875 - Mt. Woodson, San Diego
__________________________________________________
1-9 - 770.20625 - Bloomer Hill, Butte
1-13 - 770.20625 - Mt. Saint Helena, Sonoma County
1-28 - 770.20625 - Hauser Peak, Los Angeles
1-38 - 770.20625 - Plowshare Peak, Santa Barbara
__________________________________________________
1-67 - 770.40625 - Toro Peak, Riverside
__________________________________________________
1-18 - 770.44375 - Mt. Diablo, Contra Costa
1-40 - 770.44375 - Santa Ynez Peak, Santa Barbara
__________________________________________________
1-19 - 770.20625 - Sunol Ridge, Alameda
1-66 - 770.20625 - Cal OES, Sacramento
__________________________________________________
1-15 - 773.05625 - Mt. Vaca, Solano County
1-23 - 773.05625 - Mount Howell, Placer
1-47 - 773.80625 - Cuyamaca Peak, San Diego
1-51 - 773.05625 - Red Mountain, Ventura
__________________________________________________
1-16 - 773.08125 - Sonoma Mountain, Sonoma
1-21 - 773.08125 - Wolf Mountain, Nevada
1-25 - 773.08125 - South Mountain, Ventura
1-36 - 773.08125 - Calandra (Williams Hill), Monterey
1-58 - 773.08125 - Rodman Mtn, San Bernardino, County
__________________________________________________
1-48 - 773.30625 - Red Mountain (Fallbrook), San Diego
__________________________________________________
1-30 - 773.56875 - Santiago Peak, Riverside
__________________________________________________
_____________________________________________________________________________
Alternate Control Channel:
770.16875 - 770.46875 - 770.65625 - 770.69375 - 770.91875 - 770.94375 -
773.06875 - 773.29375 - 773.30625 - 773.34375 - 773.54375 - 773.55625 -
773.56875 - 773.58125 - 773.59375 - 773.78125 - 773.79375 - 773.80625 - 773.81875 -
774.05625 - 774.33125 -
_____________________________________________________________________________
CWID: 773.84375 - 774.34375 - 774.78125 - 774.79375 - 774.80625 - 774.81875 - 774.83125
_____________________________________________________________________________
Voice/Data: 770.96875 - 774.04375 - 774.08125 - 774.29375 - 774.55625 - 774.58125
_____________________________________________________________________________
_____________________________________________________________________________
_____________________________________________________________________________
CRIS Sites:
_____________________________________________________
Site:1-1 NAC: 9D1 - Pine Hill - El Dorado
769.40625 - Primary Control Channel
770.65625 - Alternate Control Channel
773.30625 - Alternate Control Channel
773.59375 - Alternate Control Channel
774.08125 - Voice
774.34375 - CWID
Site Adjacent Neighbors:
1-7 - 769.20625 - Downtown Sacramento, Sacramento
1-8 - Bald Mountain
1-15 - Mt. Vaca
1-18 - Mt. Diablo
1-21 - 773.08125 - Wolf Mountain, Nevada
1-23 - 773.05625 - Mount Howell, Placer
1-66 - 770.20625 - Cal OES, Sacramento
_____________________________________________________
Site:1-2 NAC: 9D2 - Mt. Oso, Stanislaus
769.96875 - Primary Control Channel
770.91875 - Alternate Control Channel
773.34375 - Alternate Control Channel
773.79375 - Alternate Control Channel
774.04375 -
774.78125 -
Site Adjacent Neighbors:
1-3 - Mt. Bullion
1-4 - Blue Ridge
1-5 - Joaquin Ridge
1-15 - Mt. Vaca
1-18 - Mt. Diablo
1-19 - Sunol Ridge
1-74 - Deadwood Peak
_____________________________________________________
Site:1-3 NAC: 9D3 - Mt. Bullion, Mariposa
770.20625 - Primary Control Channel
770.94375 - Alternate Control Channel
773.54375 - Alternate Control Channel
773.81875 - Alternate Control Channel
774.28125 -
774.79375 -
Site Adjacent Neighbors:
1-2 - Mt. Oso
1-4 - Blue Ridge
1-5 - Joaquin Ridge
1-63 - Crestview
1-64 - Sherwin Summit
1-74 - Deadwood Peak
_____________________________________________________
Site:1-4 NAC: 9D4 - Blue Ridge, Tulare
769.40625 - Primary Control Channel
770.65625 - Alternate Control Channel
773.30625 - Alternate Control Channel
773.59375 - Alternate Control Channel
774.08125 -
774.34375 -
Site Adjacent Neighbors:
1-3 - Mt. Bullion
1-5 - Joaquin Ridge
1-6 - Round Mountain
1-65 - Silver Peak
1-74 - Deadwood Peak
_____________________________________________________
Site:1-5 NAC: 9D5 - Joaquin Ridge, Fresno
770.44375 - Primary Control Channel
773.06875 - Alternate Control Channel
773.56875 - Alternate Control Channel
774.05625 - Alternate Control Channel
774.29375 -
774.81875 -
Site Adjacent Neighbors:
1-2 - Mt. Oso
1-3 - Mt. Bullion
1-4 - Blue Ridge
1-6 - Round Mountain
1-26 - Tejon Peak
_____________________________________________________
Site:1-6 NAC: 9D6 - Round Mountain, Kern
769.96875 - Primary Control Channel
770.91875 - Alternate Control Channel
773.34375 - Alternate Control Channel
773.79375 - Alternate Control Channel
774.04375 -
774.78125 -
Site Adjacent Neighbors:
1-1 - Pine Hill
1-2 - Mt. Oso
1-3 - Mt. Bullion
1-4 - Blue Ridge
1-5 - Joaquin Ridge
_____________________________________________________
Site:1-7 NAC: 9D7 - Downtown Sacramento
769.20625 - Primary Control Channel
770.90625 - Alternate Control Channel
773.31875 - Alternate Control Channel
774.06875 - Alternate Control Channel
774.54375 -
774.84375 -
Site Adjacent Neighbors:
1-1 - Pine Hill
1-8 - Bald Mountain
1-15 - Mt. Vaca
1-18 - Mt. Diablo
1-21 - Wolf Mountain
1-23 - Mount Howell
1-66 - Mather (Cal OES)
_____________________________________________________
Site:1-8 NAC: 9D8 - Bald Mountain, Yolo
769.90625 - Primary Control Channel
770.16875 - Alternate Control Channel
770.46875 - Alternate Control Channel
770.69375 - Alternate Control Channel
770.96875 -
773.84375 -
Site Adjacent Neighbors:
1-1 - Pine Hill
1-7 - Downtown Sacramento
1-9 - Bloomer Hill
1-10 - Tuscan Butte
1-15 - Mt. Vaca
1-21 - Wolf Mountain
1-50 - Seigler Mountain
_____________________________________________________
Site:1-9 NAC: 9D9 - Bloomer Hill, Butte
770.20625 - Primary Control Channel
770.94375 - Alternate Control Channel
773.54375 - Alternate Control Channel
773.81875 - Alternate Control Channel
774.28125 -
774.79375 -
Site Adjacent Neighbors:
1-8 - Bald Mountain
1-10 - Tuscan Butte
1-11 - South Fork Mountain
1-21 - Wolf Mountain
1-22 - Banner Mountain
1-41 - Sugarloaf Mountain
_____________________________________________________
Site:1-10 NAC: 9DA - Tuscan Butte, Tehama
769.96875 - Primary Control Channel
770.91875 - Alternate Control Channel
773.34375 - Alternate Control Channel
773.79375 - Alternate Control Channel
774.04375 -
774.78125 -
Site Adjacent Neighbors:
1-8 - Bald Mountain
1-9 - Bloomer Hill
1-11 - South Fork Mountain
_____________________________________________________
Site:1-11 NAC: 9DB - South Fork Mountain, Shasta
769.90625 - Primary Control Channel
770.16875 - Alternate Control Channel
770.46875 - Alternate Control Channel
770.69375 - Alternate Control Channel
770.96875 -
773.84375 -
Site Adjacent Neighbors:
1-10 - Tuscan Butte
1-41 - Sugarloaf Mountain
1-42 - Soda Ridge
1-43 - Antelope Mountain
1-80 - Horse Mountain
_____________________________________________________
Site:1-12 NAC: 9DC - Strawberry Peak, San Bernardino
773.05625 - Primary Control Channel
773.29375 - Alternate Control Channel
773.58125 - Alternate Control Channel
773.80625 - Alternate Control Channel
774.58125 -
774.80625 -
Site Adjacent Neighbors:
1-28 - Hauser Peak
1-29 - Mt. Lukens
1-30 - Santiago Peak
1-58 - Rodman Mountain
1-59 - Government Peak
1-67 - Toro Peak
_____________________________________________________
Site:1-13 NAC: 9DD - Mt. Saint Helena, Sonoma County
770.20625 - Primary Control Channel
770.94375 - Alternate Control Channel
773.54375 - Alternate Control Channel
773.81875 - Alternate Control Channel
774.28125 -
774.79375 - CWID
Site Adjacent Neighbors:
1-14 - English Hill
1-15 - Mt. Vaca
1-16 - Sonoma Mountain
1-50 - Seigler Mountain
1-76 - Laughlin Ridge
_____________________________________________________
Site:1-14 NAC: 9DE - English Hill, Sonoma
769.96875 - Primary Control Channel
770.91875 - Alternate Control Channel
773.34375 - Alternate Control Channel
773.79375 - Alternate Control Channel
774.04375 -
774.78125 -
Site Adjacent Neighbors:
1-13 - Mt. Saint Helena
1-16 - Sonoma Mountain
1-19 - Sunol Ridge
1-50 - Seigler Mountain
_____________________________________________________
Site:1-15 NAC: 9DF - Mt. Vaca, Solano County
773.05625 - Primary Control Channel
773.29375 - Alternate Control Channel
773.58125 - Alternate Control Channel
773.80625 - Alternate Control Channel
774.58125 -
774.80625 - CWID
Site Adjacent Neighbors:
1-1 - Pine Hill
1-2 - 769.96875 - Mt. Oso, Stanislaus
1-7 - 769.20625 - Downtown Sacramento, Sacramento
1-8 - 769.90625 - Bald Mountain, Yolo
1-16 - 773.08125 - Sonoma Mountain, Sonoma
1-17 - Mt. Tamalpais
1-18 - 770.44375 - Mt. Diablo, Contra Costa
_____________________________________________________
Site:1-16 NAC: 9D0 - Sonoma Mountain, Sonoma
773.08125 - Primary Control Channel
773.55625 - Alternate Control Channel
773.78125 - Alternate Control Channel
774.33125 - Alternate Control Channel
Site Adjacent Neighbors:
1-13 - Mt. Saint Helena
1-14 - English Hill
1-15 - Mt. Vaca
1-17 - Mt. Tamalpais
1-18 - Mt. Diablo
1-19 - Sunol Ridge
1-50 - Seigler Mountain
_____________________________________________________
Site:1-17 NAC: 9DA - Mt Tam Middle Peak, Marin
769.20625 - Primary Control Channel
770.90625 - Alternate Control Channel
773.31875 - Alternate Control Channel
774.06875 - Alternate Control Channel
774.54375 -
774.84375 -
Site Adjacent Neighbors:
1-14 - English Hill
1-15 - Mt. Vaca
1-16 - Sonoma Mountain
1-18 - Mt. Diablo
1-19 - Sunol Ridge
1-20 - Loma Prieta
_____________________________________________________
Site:1-18 NAC: 9D8 - Mt. Diablo, Contra Costa County
770.44375 - Primary Control Channel
773.06875 - Alternate Control Channel
773.56875 - Alternate Control Channel
774.05625 - Alternate Control Channel
774.29375 - Voice
774.81875 - CWID
Site Adjacent Neighbors:
1-1 - Pine Hill
1-2 - 769.96875 - Mt. Oso, Stanislaus
1-7 - Downtown Sacramento
1-15 - 773.05625 - Mt. Vaca, Solano County
1-16 - 773.08125 - Sonoma Mountain, Sonoma
1-17 - Mt. Tamalpais
1-19 - 770.20625 - Sunol Ridge, Alameda
_____________________________________________________
Site:1-19 NAC: 9D9 - Sunol Ridge, Alameda
770.20625 - Primary Control Channel
770.94375 - Alternate Control Channel
773.54375 - Alternate Control Channel
773.81875 - Alternate Control Channel
774.28125 -
774.79375 -
Site Adjacent Neighbors:
1-2 - 769.96875 - Mt. Oso, Stanislaus
1-14 - English Hill
1-16 - Sonoma Mountain
1-17 - Mt. Tamalpais
1-18 - 770.44375 - Mt. Diablo, Contra Costa
1-20 - 769.40625 - Loma Prieta, Santa Clara County
_____________________________________________________
Site:1-20 NAC: 9D0 - Loma Prieta, Santa Clara County
769.40625 - Primary Control Channel
770.65625 - Alternate Control Channel
773.30625 - Alternate Control Channel
773.59375 - Alternate Control Channel
774.08125 -
774.34375 - CWID
Site Adjacent Neighbors:
1-17 - Mt. Tamalpais
1-19 - 770.20625 - Sunol Ridge, Alameda
1-35 - Fremont Peak
1-36 - Calandra (Williams Hill)
1-104 - Call Mountain
_____________________________________________________
Site:1-21 NAC: 9D1 - Wolf Mountain - Nevada County
773.08125 - Primary Control Channel
773.55625 - Alternate Control Channel
773.78125 - Alternate Control Channel
774.33125 - Alternate Control Channel
774.55625 - Voice
774.83125 - CWID
Site Adjacent Neighbors:
1-1 - 769.40625 - Pine Hill, El Dorado
1-7 - 769.20625 - Downtown Sacramento, Sacramento
1-8 - 769.90625 - Bald Mountain, Yolo
1-9 - 770.20625 - Bloomer Hill, Butte
1-22 - 769.96875 - Banner Mountain, Nevada
1-23 - 773.05625 - Mount Howell, Placer
1-31 - Blue Canyon
_____________________________________________________
Site:1-22 NAC: 9D2 - Banner Mountain, Nevada
769.96875 - Primary Control Channel
770.91875 - Alternate Control Channel
773.34375 - Alternate Control Channel
773.79375 - Alternate Control Channel
774.04375 -
774.78125 -
Site Adjacent Neighbors:
1-9 - Bloomer Hill
1-10 - Tuscan Butte
1-21 - Wolf Mountain
1-23 - Mount Howell
1-31 - Blue Canyon
1-32 - Cisco Butte
1-33 - Donner Beacon
_____________________________________________________
Site:1-23 NAC: 9D3 - Mount Howell, Placer
773.05625 - Primary Control Channel
773.29375 - Alternate Control Channel
773.58125 - Alternate Control Channel
773.80625 - Alternate Control Channel
774.58125 - Voice
774.80625 -
Site Adjacent Neighbors:
1-1 - Pine Hill
1-21 - Wolf Mountain
1-22 - Banner Mountain
1-31 - Blue Canyon
1-32 - Cisco Butte
_____________________________________________________
Site:1-24 NAC: 9D4 - 1-24 - Rincon Peak, Ventura County
769.90625 - Primary Control Channel
770.16875 - Alternate Control Channel
770.46875 - Alternate Control Channel
770.69375 - Alternate Control Channel
770.96875 - Voice
773.84375 - CWID
Site Adjacent Neighbors:
1-25 - 773.08125 - South Mountain, Ventura
1-40 - 770.44375 - Santa Ynez Peak, Santa Barbara
1-51 - 773.05625 - Red Mountain, Ventura
_____________________________________________________
Site:1-25 NAC: 9D5 - 1-25 - South Mountain, Ventura County
773.08125 - Primary Control Channel
773.55625 - Alternate Control Channel
773.78125 - Alternate Control Channel
774.33125 - Alternate Control Channel
774.55625 -
774.83125 - CWID
Site Adjacent Neighbors:
1-24 - 769.90625 - Rincon Peak, Ventura
1-26 - 769.20625 - Tejon Peak, Los Angeles
1-27 - 769.40625 - Oat Mountain, Los Angeles
1-28 - 770.20625 - Hauser Peak, Los Angeles
1-51 - 773.05625 - Red Mountain, Ventura
_____________________________________________________
Site:1-26 NAC: 9D6 - Tejon Peak, Los Angeles
769.20625 - Primary Control Channel
770.90625 - Alternate Control Channel
773.31875 - Alternate Control Channel
774.06875 - Alternate Control Channel
774.54375 -
774.84375 -
Site Adjacent Neighbors:
_____________________________________________________
Site:1-27 NAC: 9D7 - Oat Mountain, Los Angeles
769.40625 - Primary Control Channel
770.65625 - Alternate Control Channel
773.30625 - Alternate Control Channel
773.59375 - Alternate Control Channel
774.08125 -
774.34375 - CWID
Site Adjacent Neighbors:
1-25 - 773.08125 - South Mountain, Ventura
1-26 - 769.20625 - Tejon Peak, Los Angeles
1-28 - 770.20625 - Hauser Peak, Los Angeles
1-29 - 769.96875 - Mt. Lukens, Los Angeles
1-30 - 770.44375 - Santiago Peak, Riverside
_____________________________________________________
Site:1-28 NAC: 9D8 - Hauser Peak, Los Angeles
770.20625 - Primary Control Channel
770.94375 - Alternate Control Channel
773.54375 - Alternate Control Channel
773.81875 - Alternate Control Channel
774.28125 -
774.79375 -
Site Adjacent Neighbors:
_____________________________________________________
Site:1-29 NAC: 9D9 - 1-29 - Mt. Lukens, Los Angeles
769.96875 - Primary Control Channel
770.91875 - Alternate Control Channel
773.34375 - Alternate Control Channel
773.79375 - Alternate Control Channel
774.04375 - Voice
774.78125 - CWID: WPTZ774
Site Adjacent Neighbors:
1-27 - 769.40625 - Oat Mountain
1-28 - 770.20625 - Hauser Peak
1-30 - 770.44375 - Santiago Peak
1-58 - Rodman Mountain
_____________________________________________________
Site:1-30 NAC: 9D0 - Santiago Peak, Riverside
770.44375 - Primary Control Channel
773.06875 - Alternate Control Channel
773.56875 - Alternate Control Channel
774.05625 - Alternate Control Channel
774.29375 - Voice
774.81875 - CWID: WPTZ774
Site Adjacent Neighbors:
1-27 - 769.40625 - Oat Mountain, Los Angeles
1-29 - 769.96875 - Mt. Lukens, Los Angeles
1-48 - 769.40625 - Red Mountain (Fallbrook), San Diego
1-54 - 769.96875 - Mt. Woodson, San Diego
1-58 - 773.08125 - San Bernardino, County
1-67 - 769.90625 - Toro Peak, Riverside
_____________________________________________________
Site:1-31 NAC: 9D1 - Blue Canyon, Placer
770.20625 - Primary Control Channel
770.94375 - Alternate Control Channel
773.54375 - Alternate Control Channel
773.81875 - Alternate Control Channel
774.28125 -
774.79375 -
Site Adjacent Neighbors:
1-21 - Wolf Mountain
1-22 - Banner Mountain
1-23 - Mount Howell
1-32 - Cisco Butte
1-33 - Donner Beacon
_____________________________________________________
Site:1-32 NAC: 9D2 - Cisco Butte, Placer
769.20625 - Primary Control Channel
770.90625 - Alternate Control Channel
773.31875 - Alternate Control Channel
774.06875 - Alternate Control Channel
774.54375 -
774.84375 -
Site Adjacent Neighbors:
1-22 - Banner Mountain
1-23 - Mount Howell
1-31 - Blue Canyon
1-33 - Donner Beacon
_____________________________________________________
Site:1-33 NAC: 9D3 - Donner Beacon, Nevada
770.44375 - Primary Control Channel
773.06875 - Alternate Control Channel
773.56875 - Alternate Control Channel
774.05625 - Alternate Control Channel
774.29375 -
774.81875 -
Site Adjacent Neighbors:
1-22 - Banner Mountain
1-31 - Blue Canyon
1-32 - Cisco Butte
_____________________________________________________
Site:1-35 NAC: 9D5 - Fremont Peak, Monterey
769.20625 - Primary Control Channel
770.90625 - Alternate Control Channel
773.31875 - Alternate Control Channel
774.06875 - Alternate Control Channel
774.54375 -
774.84375 -
Site Adjacent Neighbors:
1-20 - Loma Prieta
1-36 - Calandra (Williams Hill)
_____________________________________________________
Site:1-36 NAC: 9D6 - Calandra (Williams Hill), Monterey
773.08125 - Primary Control Channel
773.55625 - Alternate Control Channel
773.78125 - Alternate Control Channel
774.33125 - Alternate Control Channel
774.55625 -
774.83125 -
Site Adjacent Neighbors:
1-20 - Loma Prieta
1-35 - Fremont Peak
1-38 - Plowshare Peak
1-39 - Mt. Solomon
1-53 - Rocky Butte
_____________________________________________________
Site:1-37 NAC: - Mt. Lowe, San Luis Obispo (Deleted)
Site Adjacent Neighbors:
_________________________________
Site:1-38 NAC:9D8 - Plowshare Peak, Santa Barbara
770.20625 - Primary Control Channel
770.94375 - Alternate Control Channel
773.54375 - Alternate Control Channel
773.81875 - Alternate Control Channel
774.28125 -
774.79375 -
Site Adjacent Neighbors:
_____________________________________________________
Site:1-39 NAC: 9D9 - Mt. Solomon, Santa Barbara
769.40625 - Primary Control Channel
770.65625 - Alternate Control Channel
773.30625 - Alternate Control Channel
773.59375 - Alternate Control Channel
774.08125 -
774.34375 - CWID
Site Adjacent Neighbors:
1-36 - 773.08125 - Calandra (Williams Hill), Monterey
1-40 - 770.44375 - Santa Ynez Peak, Santa Barbara
1-53 - 769.90625 - Rocky Butte, San Luis Obispo
_____________________________________________________
Site:1-40 NAC: 9D0 - Santa Ynez Peak, Santa Barbara
770.44375 - Primary Control Channel
773.06875 - Alternate Control Channel
773.56875 - Alternate Control Channel
774.05625 - Alternate Control Channel
774.29375 -
774.81875 -
Site Adjacent Neighbors:
1-24 - 769.90625 - Rincon Peak, Ventura
1-39 - 769.40625 - Mt. Solomon, Santa Barbara
1-51 - 773.05625 - Red Mountain, Ventura
_____________________________________________________
Site:1-42 NAC: 9D2 - Soda Ridge, Siskiyou
769.20625 - Primary Control Channel
770.90625 - Alternate Control Channel
773.31875 - Alternate Control Channel
774.06875 - Alternate Control Channel
774.54375 -
774.84375 -
Site Adjacent Neighbors:
1-11 - South Fork Mountain
1-43 - Antelope Mountain
_____________________________________________________
Site:1-43 NAC: 9D3 - Antelope Mountain, Siskiyou
773.08125 - Primary Control Channel
773.55625 - Alternate Control Channel
773.78125 - Alternate Control Channel
774.33125 - Alternate Control Channel
774.55625 -
774.83125 -
Site Adjacent Neighbors
1-11 - South Fork Mountain
1-42 - Soda Ridge
_____________________________________________________
Site:1-47 NAC: 9D7 - Cuyamaca Peak
773.05625 - Primary Control Channel
773.29375 - Alternate Control Channel
773.58125 - Alternate Control Channel
773.80625 - Alternate Control Channel
774.58125 - Voice
774.80625 - CWID
Site Adjacent Neighbors:
1-67 - 769.90625 - Toro Peak, Riverside
_____________________________________________________
Site:1-48 NAC: 9D8 - Red Mountain (Fallbrook), San Diego
769.40625 - Primary Control Channel
770.65625 - Alternate Control Channel
773.30625 - Alternate Control Channel
773.59375 - Alternate Control Channel
774.08125 -
774.34375 - CWID: WPTZ774
Site Adjacent Neighbors:
1-30 - 770.44375 - Santiago Peak, Riverside
1-54 - 769.96875 - Mt. Woodson, San Diego
_____________________________________________________
Site:1-50 NAC: 9DC - Seigler Mountain, Lake
769.40625 - Primary Control Channel
770.65625 - Alternate Control Channel
773.30625 - Alternate Control Channel
773.59375 - Alternate Control Channel
774.08125 -
774.34375 -
Site Adjacent Neighbors:
1-2 - Mt. Oso
1-3 - Mt. Bullion
1-4 - Blue Ridge
1-5 - Joaquin Ridge
1-6 - Round Mountain
_____________________________________________________
Site:1-51 NAC: 9D1 - Red Mountain, Ventura County
773.05625 - Primary Control Channel
773.29375 - Alternate Control Channel
773.58125 - Alternate Control Channel
773.80625 - Alternate Control Channel
774.58125 -
774.80625 - CWID
Site Adjacent Neighbors:
1-24 - 769.90625 - Rincon Peak, Ventura
1-25 - 773.08125 - South Mountain, Ventura
1-40 - 770.44375 - Santa Ynez Peak, Santa Barbara
_____________________________________________________
Site:1-53 NAC: 9D3 - Rocky Butte, San Luis Obispo County
769.90625 - Primary Control Channel
770.16875 - Alternate Control Channel
770.46875 - Alternate Control Channel
770.69375 - Alternate Control Channel
770.96875 -
773.84375 -
Site Adjacent Neighbors:
1-36 - 773.08125 - Calandra (Williams Hill), Monterey
1-39 - 769.40625 - Mt. Solomon, Santa Barbara
_____________________________________________________
Site:1-54 NAC: 9D4 - Mt. Woodson, San Diego
769.96875 - Primary Control Channel
770.91875 - Alternate Control Channel
773.34375 - Alternate Control Channel / Voice
773.79375 - Alternate Control Channel / Voice
774.04375 - Voice
774.78125 - Voice - BSI-CWID: WPTZ774
Site Adjacent Neighbors:
1-30 - 773.56875 - Santiago Peak
1-47 - 773.80625 - Cuyamaca Peak
1-48 - 773.30625 - Red Mountain (Fallbrook)
1-67 - 770.40625 - Toro Peak, Riverside
_____________________________________________________
Site:1-56 NAC: 9D6 - Chuckwalla Mtn, Riverside County
769.40625 - Primary Control Channel
770.65625 - Alternate Control Channel
773.30625 - Alternate Control Channel
773.59375 - Alternate Control Channel
774.08125 -
774.34375 -
Site Adjacent Neighbors:
1-67 - Toro Peak
_____________________________________________________
Site:1-58 NAC: 9D8 - Rodman Mtn, San Bernardino, County
773.08125 - Primary Control Channel
773.55625 - Alternate Control Channel
773.78125 - Alternate Control Channel
774.33125 - Alternate Control Channel
774.55625 -
774.83125 -
Site Adjacent Neighbors:
1-28 - Hauser Peak
1-29 - Mt. Lukens
1-30 - Santiago Peak
1-59 - Government Peak
1-67 - Toro Peak
_____________________________________________________
Site:1-59 NAC: 9D9 - Government Peak, Kern
770.44375 - Primary Control Channel
773.06875 - Alternate Control Channel
773.56875 - Alternate Control Channel
774.05625 - Alternate Control Channel
774.29375 -
774.81875 -
Site Adjacent Neighbors:
1-28 - Hauser Peak
1-58 - Rodman Mountain
_____________________________________________________
Site:1-60 NAC: 9D0 - Leviathan Peak, Alpine - WRPW349
151.1975 - Primary Control Channel
151.4525 - Alternate Control Channel
154.2425 -
155.1825 -
Site Adjacent Neighbors:
1-61 - Sweetwater Mountain
1-62 - Conway Summit
1-63 - Crestview
1-64 - Sherwin Summit
1-65 - Silver Peak
1-69 - Mammoth Lakes FS1
_____________________________________________________
Site:1-61 NAC: 9D1 - Sweetwater Mountain, Mono - WRPH873
154.3175 - Primary Control Channel
154.8525 - Alternate Control Channel
155.1525 -
155.3550 -
Site Adjacent Neighbors:
1-60 - Leviathan Peak
1-62 - Conway Summit
1-63 - Crestview
1-64 - Sherwin Summit
1-69 - Mammoth Lakes FS1
_____________________________________________________
Site:1-62 NAC: 9D2 - Conway Summit, Mono - WROV267
151.1450 - Primary Control Channel
154.1825 - Alternate Control Channel
154.8150 -
155.3250 -
Site Adjacent Neighbors:
1-63 - Crestview
1-64 - Sherwin Summit
_____________________________________________________
Site:1-63 NAC: 9D3 - Crestview, Mono - WROV271
151.2050 - Primary Control Channel
154.2050 - Alternate Control Channel
154.7625 -
155.1300 -
Site Adjacent Neighbors:
1-3 - Mt. Bullion
1-62 - Conway Summit
1-64 - Sherwin Summit
1-65 - Silver Peak
_____________________________________________________
Site:1-64 NAC: 9D4 - Sherwin Summit, Mono - WROU856
151.0025 - Primary Control Channel
151.2350 - Alternate Control Channel
151.4525 -
154.1675 -
Site Adjacent Neighbors:
1-3 - Mt. Bullion
1-62 - Conway Summit
1-63 - Crestview
1-65 - Silver Peak
_____________________________________________________
Site:1-65 NAC: 9D5 - Silver Peak, Inyo - WROY819
154.3625 - Primary Control Channel
154.7475 - Alternate Control Channel
155.2275 - Alternate Control Channel
155.4525 -
Site Adjacent Neighbors:
1-4 - Blue Ridge
1-63 - Crestview
1-64 - Sherwin Summit
_____________________________________________________
Site:1-66 NAC: 9D6 - Cal OES, Sacramento
770.20625 - Primary Control Channel
770.94375 - Alternate Control Channel
773.54375 - Alternate Control Channel
773.81875 - Alternate Control Channel
774.28125 -
774.79375 -
Site Adjacent Neighbors:
1-1 - Pine Hill
1-7 - Downtown Sacramento
_____________________________________________________
Site:1-67 NAC: 9D7 - Toro Peak, Riverside
769.95625 - Primary Control Channel
770.40625 - Alternate Control Channel
770.95625 - Alternate Control Channel
773.03125 - Alternate Control Channel
773.28125 -
774.31875 -
Site Adjacent Neighbors:
1-30 - 770.44375 - Santiago Peak, Riverside
1-47 - 773.05625 - Cuyamaca Peak, San Diego
1-48 - 769.40625 - Red Mountain, San Diego
1-54 - 769.96875 - Mt. Woodson, San Diego
1-56 - 769.40625 - Riverside County
1-58 - 773.08125 - San Bernardino, County
_____________________________________________________
Site:1-69 NAC: 9D9 - Mammoth Lakes FS1, Mono - WRZR827
151.1000 - Primary Control Channel
155.1675 - Alternate Control Channel
155.7225 -
156.1050 -
Site Adjacent Neighbors:
1-60 - Leviathan Peak
1-61 - Sweetwater Mountain
1-62 - Conway Summit
1-64 - Sherwin Summit
1-65 - Silver Peak
_____________________________________________________
Site:1-74 NAC: 9D4 - Deadwood Peak, Madera
769.90625 - Primary Control Channel
770.16875 - Alternate Control Channel
770.46875 - Alternate Control Channel
770.69375 - Alternate Control Channel
770.96875 -
773.84375 -
Site Adjacent Neighbors:
1-3 - Mt. Bullion
1-4 - Blue Ridge
_____________________________________________________
Site: 1-76 - NAC:9D6 - Laughlin Ridge - (Mendocino) - WRXX326
151.2050 - Control Channel
154.6725 - Control Channel
154.9050
155.5125
Site Adjacent Neighbors:
1-13 - Mt. Saint Helena
1-50 - Seigler Mountain
1-77 - Cahto Peak
1-78 - Pratt Mountain
_____________________________________________________
Site: 1-77 - NAC:9D7 - Cahto Peak - (Mendocino) - WRWX353
151.1300
154.8000 - Control Channel
155.2350
155.4450 - Control Channel
Site Adjacent Neighbors:
1-76 - Laughlin Ridge
1-78 - Pratt Mountain
_____________________________________________________
Site: 1-78 - NAC:9D1 - Pratt Mountain - (Humboldt) - WRXS988
154.6650 - Control Channel
155.2050
155.4900 - Control Channel
155.9625
Site Adjacent Neighbors:
1-50 - Seigler Mountain
1-76 - Laughlin Ridge
1-77 - Cahto Peak
1-79 - Mt. Pierce
1-80 - Horse Mountain
1-81 -
_____________________________________________________
Site: 1-79 - NAC:9D9 - Mt. Pierce - (Humboldt) - WSEV735
151.2350 - Control Channel
151.4600
154.8825
155.7300
Site Adjacent Neighbors:
1-76 - Laughlin Ridge
1-77 - Cahto Peak
1-78 - Pratt Mountain
1-80 - Horse Mountain
_____________________________________________________
Site: 1-80 - NAC:9D0 - Horse Mountain - (Humboldt) - WRYB455
151.2125 - Control Channel
151.4300 - Control Channel
154.7250 - Control Channel
155.3250
Site Adjacent Neighbors:
1-42 - Soda Ridge
1-78 - Pratt Mountain
_____________________________________________________
Site: 1-83 - NAC:9D3 - Big Valley Mountain - (Lassen) - WRWM655
154.0625 - Control Channel
154.3925 - Control Channel
155.0325
155.2950
Site Adjacent Neighbors:
1-11 - South Fork Mountain
1-41 - Sugarloaf Mountain
1-42 - Soda Ridge
1-43 - Antelope Mountain
1-84 - Likely Mountain
1-85 - Shaffer Mountain
1-86 - Hoadley Peak
_____________________________________________________
Site: 1-84 - NAC:9D4 - Likely Mountain - (Lassen) - WRWQ984
154.0475 - Control Channel
154.3625 - Control Channel
155.2575
156.1425
Site Adjacent Neighbors:
_____________________________________________________
Site: 1-85 - NAC:9D5 - Shaffer Mountain - (Lassen) - WRWY413
154.4075 - Control Channel
155.2425 - Control Channel
155.4900
155.8125
Site Adjacent Neighbors:
1-42 - Soda Ridge
1-83 - Big Valley Mountain
1-84 - Likely Mountain
_____________________________________________________
Site: 1-86 - NAC:9D6 - Hoadley Peak - (Shasta) - WRYB456
154.7025 - Control Channel
154.9425 - Control Channel
155.4600 - Control Channel
155.6550
Site Adjacent Neighbors:
1-11 - South Fork Mountain
1-41 - Sugarloaf Mountain
1-42 - Soda Ridge
1-80 - Horse Mountain
1-83 - Big Valley Mountain
_____________________________________________________
Site: 1-87 - NAC:9D7 - Hatchet Mountain - (Shasta) - WRXN540
154.7550 - Control Channel
154.9650 - Control Channel
155.4375 - Control Channel
155.9625
Site Adjacent Neighbors:
1-86 - Hoadley Peak
_____________________________________________________
Site: 1-104 - NAC:9D4 - Call Mountain - (San Benito) - WSHZ291
154.6950 - Control Channel
154.9350 - Control Channel
155.8200
156.1875 - Control Channel
Site Adjacent Neighbors:
1-20 - Loma Prieta
1-36 - Calandra (Williams Hill)
_____________________________________________________
_____________________________________________________
_____________________________________________________
Re: California Radio Interoperable System (CRIS) - 9D2 - Sites Logs - Statewide Logs
Posted: Wed Sep 27, 2023 11:35 am
by Brian
June new CRIS licensees added in the 2nd post above. (For Northern California area)
FCC Search: California State Pending only (
Link)
New Pending licenses for Northern California areas for CRIS System.
https://fccgrantslists.blogspot.com/p/california-radio-interoperable-system.html
https://california-cris.blogspot.com/p/california-cris-9d2-vhf-licenses.html
https://california-cris.blogspot.com
_______________________________________
_______________________________________
CRIS 1-12
https://california-cris.blogspot.com/p/ ... -peak.html
Please don't post them on the RadioReference Forum or Wiki or Database. Thanks!
Re: California Radio Interoperable System (CRIS) - 9D2 - Sites Logs - Statewide Logs
Posted: Thu Oct 19, 2023 12:46 pm
by Brian
CRIS Logs from October,2023 Cruise Coastal Trip
___________________________________________________________
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-13 - Mt. Saint Helena, Sonoma County
Tower Number (Hex) : T010D
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Tue Oct 3 12:48:59 2023
Site NAC: 9DD
10/3/2023 12:47 Station ID 774.79375 WPTZ774
10/3/2023 12:47 Station ID 774.79375 WPTZ774
-Tables
#Format: Table ID,Base Freq,Spacing,Input Off set,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1312","c",770.20625,"01-1312",800.20625,0,0
"01-1430","a",770.94375,"01-1430",800.94375,0,0
"01-1846","a",773.54375,"01-1846",803.54375,0,0
"01-1890","a",773.81875,"01-1890",803.81875,1,0
"01-2046","i",774.79375,"01-2046",804.79375,0,2
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
108,"T0108",9d2,"01-1264",769.90625 - Bald Mountain, Yolo
114,"T010E",9d2,"01-1274",769.96875 - English Hill, Sonoma
115,"T010F",9d2,"01-1768",773.05625 - Mt. Vaca, Solano County
116,"T0110",9d2,"01-1772",773.08125 - Sonoma Mountain, Sonoma
150,"T0132",9d2,"01-1184",769.40625 - Seigler Mountain, Lake
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-15 - Mt. Vaca, Solano County
Tower Number (Hex) : T010F
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Tue Oct 3 13:50:55 2023
Site NAC:9DF
10/3/2023 13:47 Station ID 774.80625 WPTZ774
14631,"TG: 748 DT: 10/3/23@13:46"
-Tables
#Format: Table ID,Base Freq,Spacing,Input Off set,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1768","c",773.05625,"01-1768",803.05625,0,0
"01-1806","a",773.29375,"01-1806",803.29375,0,0
"01-1852","a",773.58125,"01-1852",803.58125,0,0
"01-1888","a",773.80625,"01-1888",803.80625,1,0
"01-2048","i",774.80625,"01-2048",804.80625,0,1
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
102,"T0102",9d2,"01-1274",769.96875 - Mt. Oso, Stanislaus
107,"T0107",9d2,"01-1152",769.20625 - Downtown Sacramento, Sacramento
108,"T0108",9d2,"01-1264",769.90625 - Bald Mountain, Yolo
113,"T010D",9d2,"01-1312",770.20625 - Mt. Saint Helena, Sonoma County
114,"T010E",9d2,"01-1274",769.96875 - English Hill, Sonoma
116,"T0110",9d2,"01-1772",773.08125 - Sonoma Mountain, Sonoma
118,"T0112",9d2,"01-1350",770.44375 - Mt. Diablo, Contra Costa
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-18 - Mt. Diablo, Contra Costa County
Tower Number (Hex) : T0112
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Tue Oct 3 13:21:40 2023
Site NAC: 9D8
10/3/2023 13:17 Station ID 774.81875 WPTZ774
Talkgroups:
790,50,"T: 118 DT: 10/3/23@12:58
1392,50,"T: 118 DT: 10/3/23@12:51
1393,50,"T: 118 DT: 10/3/23@12:51
1602,50,"T: 118 DT: 10/3/23@13:15
RadioIDs:
14624,"TG: 790 DT: 10/3/23@12:58
60031,"DT: 10/3/23@13:07",1696363719
60033,"DT: 10/3/23@13:15",1696364308
60035,"DT: 10/3/23@13:13",1696364293
60037,"TG: 1393 DT: 10/3/23@12:51
60038,"TG: 1392 DT: 10/3/23@12:51
60039,"DT: 10/3/23@13:16
60040,"TG: 1392 DT: 10/3/23@13:13
64183,"TG: 1602 DT: 10/3/23@13:15"
64252,"TG: 1602 DT: 10/3/23@13:17"
-Tables
#Format: Table ID,Base Freq,Spacing,Input Off set,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1350","c",770.44375,"01-1350",800.44375,0,0
"01-1770","a",773.06875,"01-1770",803.06875,0,0
"01-1850","a",773.56875,"01-1850",803.56875,1,0
"01-1928","a",774.05625,"01-1928",804.05625,0,0
"01-1966","d",774.29375,"01-1966",804.29375,0,0
"01-2050","i",774.81875,"01-2050",804.81875,0,1
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
102,"T0102",9d2,"01-1274",769.96875 - Mt. Oso, Stanislaus
115,"T010F",9d2,"01-1768",773.05625 - Mt. Vaca, Solano County
116,"T0110",9d2,"01-1772",773.08125 - Sonoma Mountain, Sonoma
119,"T0113",9d2,"01-1312",770.20625 - Sunol Ridge, Alameda
120,"T0114",9d2,"01-1184",769.40625 - Loma Prieta, Santa Clara County
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-19 - Sunol Ridge, Alameda
Tower Number (Hex) : T0113
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Wed Oct 4 00:26:22 2023
-Tables
#Format: Table ID,Base Freq,Spacing,Input Off set,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1312","c",770.20625,"01-1312",800.20625,0,0
"01-1430","a",770.94375,"01-1430",800.94375,0,0
"01-1846","a",773.54375,"01-1846",803.54375,0,0
"01-1890","a",773.81875,"01-1890",803.81875,1,0
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
102,"T0102",9d2,"01-1274",769.96875 - Mt. Oso, Stanislaus
118,"T0112",9d2,"01-1350",770.44375 - Mt. Diablo, Contra Costa
120,"T0114",9d2,"01-1184",769.40625 - Loma Prieta, Santa Clara County
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-20 - Loma Prieta, Santa Clara County
Tower Number (Hex) : T0114
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Wed Oct 4 10:22:21 2023
Site NAC: 9D0
10/4/2023 10:17 Station ID 774.34375 WPTZ774
-Tables
#Format: Table ID,Base Freq,Spacing,Input Off set,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1184","c",769.40625,"01-1184",799.40625,0,0
"01-1384","a",770.65625,"01-1384",800.65625,0,0
"01-1808","a",773.30625,"01-1808",803.30625,0,0
"01-1854","a",773.59375,"01-1854",803.59375,1,0
"01-1974","i",774.34375,"01-1974",804.34375,0,1
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
118,"T0112",9d2,"01-1350",770.44375 - Mt. Diablo, Contra Costa
119,"T0113",9d2,"01-1312",770.20625 - Sunol Ridge, Alameda
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-24 - Rincon Peak, Ventura County
Tower Number (Hex) : T0118
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Mon Oct 2 08:39:45 2023
Site NAC: 9D4
10/2/2023 8:17 Station ID 01-1894 773.84375 WPTZ774
10/2/2023 8:17 Station ID 01-1894 773.84375 WPTZ774
10/2/2023 8:17 Station ID 01-1894 773.84375 WPTZ774
10/2/2023 8:18 Station ID 01-1894 773.84375 WPTZ774
10/2/2023 8:33 Group 03-1435 770.96875/1 143 T: 124 DT: 10/2/23@8:33 410 TG: 143 DT: 10/2/23@8:33
10/2/2023 8:34 Group 03-1435 770.96875/1 143 T: 124 DT: 10/2/23@8:33 410 TG: 143 DT: 10/2/23@8:33
Talkgroups:
143,50,"T: 124 DT: 10/2/23@8:33
RadioIDs:
410,"TG: 143 DT: 10/2/23@8:33",1696260857,"10/02/2023 @ 08:34","#000000","#000000"
-Tables
#Format: Table ID,Base Freq,Spacing,Input Off set,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1264","c",769.90625,"01-1264",799.90625,0,0
"01-1306","a",770.16875,"01-1306",800.16875,0,0
"01-1354","a",770.46875,"01-1354",800.46875,1,0
"01-1390","a",770.69375,"01-1390",800.69375,0,0
"01-1894","i",773.84375,"01-1894",803.84375,0,4
"03-1435","v",770.96875/1,"03-1435",800.96875/1,0,6
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
125,"T0119",9d2,"01-1772",773.08125 - South Mountain, Ventura
140,"T0128",9d2,"01-1350",770.44375 - Santa Ynez Peak, Santa Barbara
151,"T0133",9d2,"01-1768",773.05625 - Red Mountain, Ventura
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-25 - South Mountain, Ventura County
Tower Number (Hex) : T0119
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Timestamp : Mon Oct 2 17:02:09 2023
Site NAC: 9D5
-Tables
#Format: Table ID,Base Freq,Spacing,Input Off set,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1772","c",773.08125,"01-1772",803.08125,0,0
"01-1848","a",773.55625,"01-1848",803.55625,0,0
"01-1884","a",773.78125,"01-1884",803.78125,1,0
"01-1972","a",774.33125,"01-1972",804.33125,1,0
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
124,"T0118",9d2,"01-1264",769.90625 - Rincon Peak, Ventura
126,"T011A",9d2,"01-1152",769.20625 - Tejon Peak, Los Angeles
127,"T011B",9d2,"01-1184",769.40625 - Oat Mountain, Los Angeles
128,"T011C",9d2,"01-1312",770.20625 - Hauser Peak, Los Angeles
151,"T0133",9d2,"01-1768",773.05625 - Red Mountain, Ventura
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-27 - Oat Mountain, Los Angeles County
Tower Number (Hex) : T011B
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Mon Oct 2 17:19:44 2023
Site NAC: 9D7
10/2/2023 17:17 Station ID 774.34375 WPTZ774
TalkGroups:
1626,50,"T: 127 DT: 10/2/23@17:17"
RadioIDs:
64125,"TG: 1626 DT: 10/2/23@17:17"
-Tables
#Format: Table ID,Base Freq,Spacing,Input Off set,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1184","c",769.40625,"01-1184",799.40625,0,0
"01-1384","a",770.65625,"01-1384",800.65625,0,0
"01-1808","a",773.30625,"01-1808",803.30625,1,0
"01-1854","a",773.59375,"01-1854",803.59375,0,0
"01-1974","i",774.34375,"01-1974",804.34375,0,1
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
125,"T0119",9d2,"01-1772",773.08125 - South Mountain, Ventura
126,"T011A",9d2,"01-1152",769.20625 - Tejon Peak, Los Angeles
128,"T011C",9d2,"01-1312",770.20625 - Hauser Peak, Los Angeles
129,"T011D",9d2,"01-1274",769.96875 - Mt. Lukens, Los Angeles
130,"T011E",9d2,"01-1350",770.44375 - Santiago Peak, Riverside
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-39 - Mt. Solomon, Santa Barbara
Tower Number (Hex) : T0127
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Mon Oct 2 23:19:24 2023
Site NAC: 9D9
10/2/2023 23:17 Station ID 774.34375 WPTZ774
-Tables
#Format: Table ID,Base Freq,Spacing,Input Off set,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1184","c",769.40625,"01-1184",799.40625,0,0
"01-1384","a",770.65625,"01-1384",800.65625,0,0
"01-1808","a",773.30625,"01-1808",803.30625,0,0
"01-1854","a",773.59375,"01-1854",803.59375,1,0
"01-1974","i",774.34375,"01-1974",804.34375,0,1
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
136,"T0124",9d2,"01-1772",773.08125 - Calandra (Williams Hill), Monterey
140,"T0128",9d2,"01-1350",770.44375 - Santa Ynez Peak, Santa Barbara
153,"T0135",9d2,"01-1264",769.90625 - Rocky Butte, San Luis Obispo
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-40 - Santa Ynez Peak, Santa Barbara
Tower Number (Hex) : T0128
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Mon Oct 2 08:48:37 2023
10/2/2023 8:47 Station ID 774.81875 WPTZ774
10/2/2023 17:47 Station ID 774.81875 WPTZ774
-Tables
#Format: Table ID,Base Freq,Spacing,Input Off set,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1350","c",770.44375,"01-1350",800.44375,0,0
"01-1770","a",773.06875,"01-1770",803.06875,0,0
"01-1850","a",773.56875,"01-1850",803.56875,1,0
"01-1928","a",774.05625,"01-1928",804.05625,1,0
"01-2050","i",774.81875,"01-2050",804.81875,0,1
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
124,"T0118",9d2,"01-1264",769.90625 - Rincon Peak, Ventura
139,"T0127",9d2,"01-1184",769.40625 - Mt. Solomon, Santa Barbara
151,"T0133",9d2,"01-1768",773.05625 - Red Mountain, Ventura
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-51 - Red Mountain, Ventura
Tower Number (Hex) : T0133
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Mon Oct 2 16:57:11 2023
Site NAC: 9D1
10/2/2023 16:47 Station ID 774.80625 WPTZ774
-Tables
#Format: Table ID,Base Freq,Spacing,Input Off set,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1768","c",773.05625,"01-1768",803.05625,0,0
"01-1806","a",773.29375,"01-1806",803.29375,0,0
"01-1852","a",773.58125,"01-1852",803.58125,1,0
"01-1888","a",773.80625,"01-1888",803.80625,1,0
"01-2048","i",774.80625,"01-2048",804.80625,0,1
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
124,"T0118",9d2,"01-1264",769.90625 - Rincon Peak, Ventura
125,"T0119",9d2,"01-1772",773.08125 - South Mountain, Ventura
140,"T0128",9d2,"01-1350",770.44375 - Santa Ynez Peak, Santa Barbara
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-53 - Rocky Butte, San Luis Obispo
Tower Number (Hex) : T0135
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Tue Oct 3 02:18:14 2023
Site NAC: 9D3
10/3/2023 2:17 Station ID 01-1894 773.84375 WPTZ774
10/4/2023 10:47 Station ID 01-1894 773.84375 WPTZ774
10/4/2023 10:47 Station ID 01-1894 773.84375 WPTZ774
-Tables
#Format: Table ID,Base Freq,Spacing,Input Off set,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1264","c",769.90625,"01-1264",799.90625,0,0
"01-1306","a",770.16875,"01-1306",800.16875,0,0
"01-1354","a",770.46875,"01-1354",800.46875,0,0
"01-1390","a",770.69375,"01-1390",800.69375,1,0
"01-1894","i",773.84375,"01-1894",803.84375,0,1
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
136,"T0124",9d2,"01-1772",773.08125 - Calandra (Williams Hill), Monterey
139,"T0127",9d2,"01-1184",769.40625 - Mt. Solomon, Santa Barbara
___________________________________________________________
-TowerInfo
System ID : 9D2
WACN : BEE00
Tower Number (Decimal): 1-54 - Mt. Woodson, San Diego
Tower Number (Hex) : T0136
Control Capabilities : Data,Voice,Registration
Flavor : Phase 2
Call Sign(s) : WPTZ774
Timestamp : Thu Oct 19 14:28:28 2023
10/19/2023 13:10 Station ID 774.78125 WPTZ774
10/19/2023 13:11 Station ID 774.78125 WPTZ774
10/19/2023 13:40 Station ID 774.78125 WPTZ774
10/19/2023 14:10 Station ID 774.78125 WPTZ774
10/19/2023 14:10 Station ID 774.78125 WPTZ774
10/19/2023 12:54 Group 774.04375 1973 T: 154 DT: 10/19/23@12:54 67504 TG: 1973 DT: 10/19/23@12:54
10/19/2023 12:54 Group 774.04375 1973 T: 154 DT: 10/19/23@12:54 67500
10/19/2023 13:00 Group 774.04375 1973 T: 154 DT: 10/19/23@12:54 67536 TG: 1973 DT: 10/19/23@13:00
10/19/2023 13:00 Group 774.04375 1973 T: 154 DT: 10/19/23@12:54 67536 TG: 1973 DT: 10/19/23@13:00
10/19/2023 13:00 Group 774.04375 1973 T: 154 DT: 10/19/23@12:54 67500 TG: 1973 DT: 10/19/23@12:54
10/19/2023 13:01 Group 774.04375 1973 T: 154 DT: 10/19/23@12:54 67505
10/19/2023 13:13 Group 774.04375 1973 T: 154 DT: 10/19/23@12:54 67516 TG: 1973 DT: 10/19/23@13:13
10/19/2023 13:14 Group 774.04375 1973 T: 154 DT: 10/19/23@12:54 67500 TG: 1973 DT: 10/19/23@12:54
Talkgroups:
141,50,"T: 154 DT: 10/19/23@13:24","N",0,0
1973,50,"T: 154 DT: 10/19/23@12:54","N",15,0
Radios:
508,"TG: 141 DT: 10/19/23@13:24
67500,"TG: 1973 DT: 10/19/23@12:54
67504,"TG: 1973 DT: 10/19/23@12:54
67505,"TG: 1973 DT: 10/19/23@13:01
67516,"TG: 1973 DT: 10/19/23@13:13
67536,"TG: 1973 DT: 10/19/23@13:00
-Tables
#Format: Table ID,Base Freq,Spacing,Input Off set,Assumed/Confirmed,BandWidth,Slots
00,851.00625,0.00625,-45.00000,"Confirmed",0.01250,1
01,762.00625,0.00625,30.00000,"Confirmed",0.01250,1
02,851.01250,0.01250,-45.00000,"Confirmed",0.01250,2
03,762.00625,0.01250,30.00000,"Confirmed",0.01250,2
06,151.00000,0.00250,0.00500,"Confirmed",0.01250,1
07,157.00000,0.00250,0.00500,"Confirmed",0.01250,1
08,151.00000,0.00250,0.00500,"Confirmed",0.01250,2
09,157.00000,0.00250,0.00500,"Confirmed",0.01250,2
-Frequencies
#Format: Channel,Usage,Frequency(/Slot),Input Channel,Input Frequency(/Slot),Input Explicit(1/0),Hit Count
"01-1274","c",769.96875,"01-1274",799.96875,0,0
"01-1426","a",770.91875,"01-1426",800.91875,0,0
"01-1814","a",773.34375,"01-1814",803.34375,0,0
"01-1886","a",773.79375,"01-1886",803.79375,1,0
"01-1926","v",774.04375,"01-1926",804.04375,0,15
"01-2044","i",774.78125,"01-2044",804.78125,0,5
-Neighbors
#Format: TowerID,TowerIDHex,System ID,Channel,Frequency
130,"T011E",9d2,"01-1350",770.44375 - Santiago Peak, Riverside
148,"T0130",9d2,"01-1184",769.40625 - Red Mountain (Fallbrook), San Diego
167,"T0143",9d2,"01-1264",769.90625 - Toro Peak, Riverside
___________________________________________________________
___________________________________________________________
Reminder: Please do not submit, or share any info with RadioReference per California Scanner Community.
Everyone is doing great this year by not submitting to RadioReference Database.
California Radio Interoperable System (CRIS) - 9D2
Posted: Wed Nov 15, 2023 2:52 pm
by Brian
California Radio Interoperable System - CRIS - 9D2
Site Information, Site Logs, Primary Control Channel, Alternate Control Channel
Advance Information not available on RadioReference.
https://California-CRIS.blogspot.com
California CRIS 9D2 VHF Licenses
https://California-CRIS.blogspot.com/p/ ... enses.html
California Radio Interoperable System CRIS 9D2 -
Contours Maps for the 26 VHF sites.
https://california-cris.blogspot.com/p/ ... s-map.html
California Radio Interoperable System (CRIS) - 9D2 - Talkgroups
https://california-cris.blogspot.com/p/ ... roups.html
_____________________________________________
Site Name ----- County ----------------- Lat, Long
La Habra - Los Angeles County 33.97333, -117.94311
Los Pinetos - Los Angeles County 34.35469, -118.45952
Loma Ridge - Orange County 33.746609, -117.721596
Inland Empire - San Bernardino County 34.12916, -117.50255
Onyx Peak - San Bernardino County 34.19191, -116.70919
Blythe - Riverside County 33.60416, -114.59633
Cactus City - Riverside County 33.65891, -115.98608
Indio CHP - Riverside County 33.75188, -116.27288
Indio Hill - Riverside County 33.80197, -116.22527
Perris CDF - Riverside County 33.7875, -117.23111
Boucher Hill - San Diego County 33.33452, -116.91936
Monte Vista Hilltop - San Diego County 32.75033, -116.9203
San Miguel - San Diego County 32.69616, -116.93752
Pelato Mtn - Kern County 34.91997, -119.40511
Frazier - Ventura County 34.77497, -118.96955
Piedras Blancas - San Luis Obispo County 35.66611, -121.28386
Caldecott - Alameda County 37.85488, -122.21786
Caples Lake - Alpine County 38.7088, -120.0388
Mt. Madonna - Santa Clara County 37.01075, -121.70522
Petaluma - Sonoma County 38.23658, -122.62163
Sleepy Mtn - Sonoma County 38.232, -122.4973
_____________________________________________
Re: California Radio Interoperable System (CRIS) - 9D2 - Sites Logs - Statewide Logs
Posted: Sun Dec 21, 2025 1:32 pm
by Brian
